Madison Avenue Corridor Improvement Project
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
The Madison Avenue project is a critical corridor that connects to several major thoroughfares within the City of Loveland like Highway 287, E 29th Street, E 37th Street and Monroe Avenue. As one of Loveland’s major connectors, it’s an essential road to the City’s overall transportation system’s wellbeing. As the City assesses and improves multi-modal transportation, Madison Avenue is among the top roads that seeks to improve pedestrian and bicycle enhancements.
As part of Connect Loveland, the City’s Transportation Master Plan that was approved in October 2023, the current conditions of Madison Avenue range from a standard four-lane section to a two-lane rural section, which lacks essential amenities like bike lanes and sidewalks. The improvements include:
- Buffered bike lanes on Madison Avenue from 29th Street to the newly constructed roundabout.
- Construction of sidewalks to the east side of the road between Seven Lakes Drive to 37th Street.
- Addition of two way left hand turn lane along Madison Avenue and left turn lane to Seven Lakes Drive.
- A new roundabout at Madison Avenue and 37th Street with crosswalks and buffered bike lanes.
- Additional art piece of a dandelion to Loveland’s 500+ sculptures by Loveland artist Karen Cusolito. Approved by Art in Public Places, as well as funded by the organization.
To limit public disturbances and costs, the Public Works and Utilities Departments will complete the roadway and utility improvements at the same time to lessen disruptions. The project addresses bicycle and pedestrian improvements, relocation of utilities and improvements to overhead powerlines within the corridor that have reached their lifespan.
Project Vision
To transform Madison Avenue into a safe, efficient, and multimodal corridor that enhances connectivity, improves accessibility, and supports Loveland’s long-term multimodal transportation goals. This project will upgrade infrastructure, add bike lanes and sidewalks, improve utilities, and enhance traffic flow—creating a more sustainable and inclusive transportation network for all.
Project Impacts
By early July, the City of Loveland aims to begin construction, starting with underground water and stormwater utility improvements. Once infrastructure improvements are complete, the City of Loveland will focus on surface improvements determined by the streetscape design. Between utility and streetscape improvements, the project is anticipated to take six to eight months to construct.

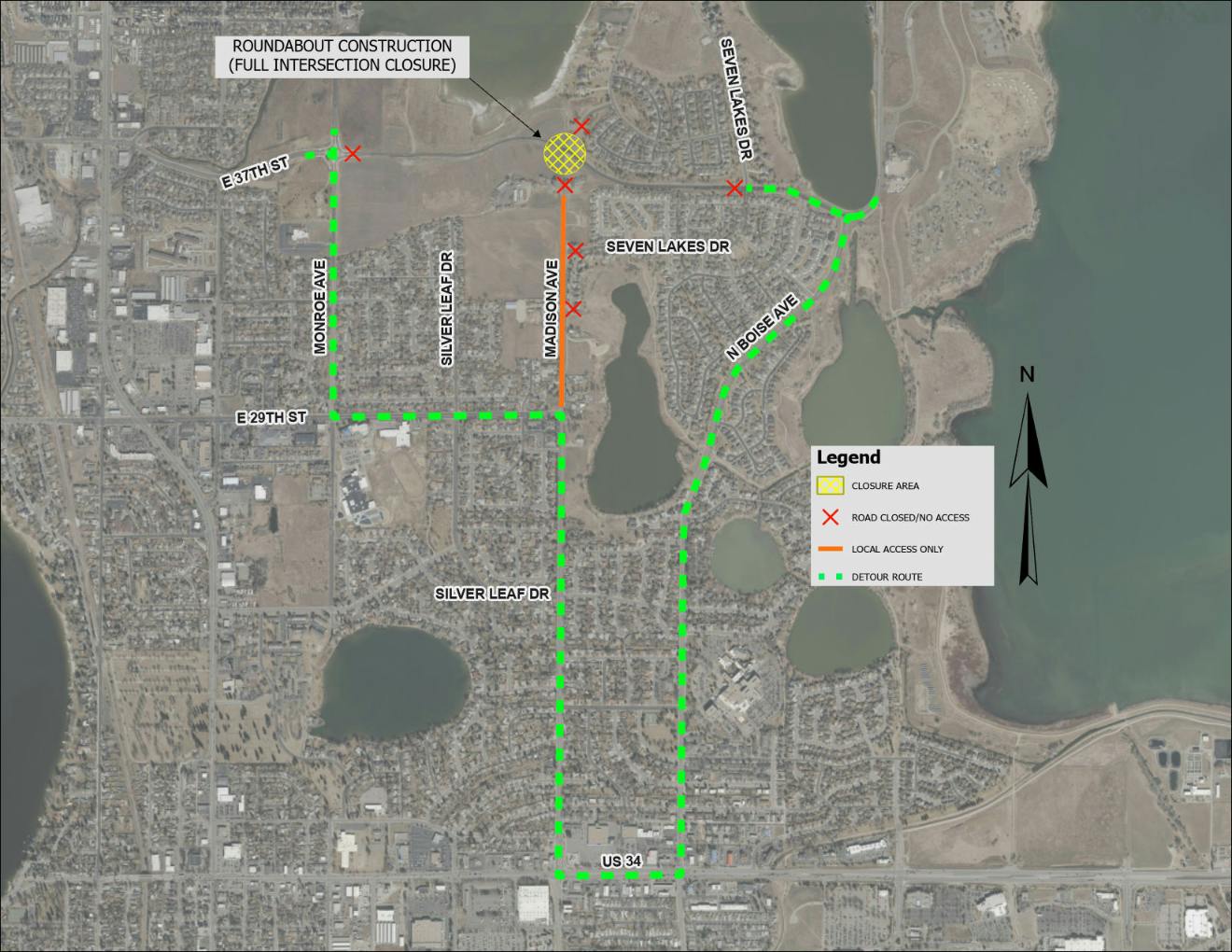

The intersection of Madison and 37th will be closed while the roundabout is constructed at the intersection. To facilitate detour efficiency, the intersection of 33rd and Monroe Avenue has been converted into a two-way stop from a four-way stop to accommodate the detour traffic.
Project Goals
- Offer improved safety and transportation options for people whether they are driving, walking, or biking.
- Focus on modes of travel – making improvements to travel lanes, bike lanes and sidewalks along the corridor.
- Upgrades to improve safety at the intersections and along the corridor
- Improved connectivity to US Highway 287 and beyond to Taft Avenue.
- Effective use of City funds – combine and coordinate roadway and utility improvements and relocations to lessen public disruption.
Project Funding
- 2019-2024 General Fund = 20%
- 2019-2024 Capital Expansion Fees (CEF) = 80%
- Appropriations of funds for the project began in 2019.
- Design services for the project were completed in 2021.
- Contracted for the project awarded in April 2021.
- Contractor awarded for the project in May 2025.
Stay Informed
To stay informed about this project, subscribe to our email list in the "Stay Informed" section. We understand construction can cause disruptions. If you have a question about the project or would like to contact the project team, email PublicWorksInfo@cityofloveland.org or call 970-962-3669. Please allow us to respond to your requests within 24-48 hours. You may also add your question or comment in the "Questions and Answers" section. Thank you for your patience while this work is being completed.
The Madison Avenue project is a critical corridor that connects to several major thoroughfares within the City of Loveland like Highway 287, E 29th Street, E 37th Street and Monroe Avenue. As one of Loveland’s major connectors, it’s an essential road to the City’s overall transportation system’s wellbeing. As the City assesses and improves multi-modal transportation, Madison Avenue is among the top roads that seeks to improve pedestrian and bicycle enhancements.
As part of Connect Loveland, the City’s Transportation Master Plan that was approved in October 2023, the current conditions of Madison Avenue range from a standard four-lane section to a two-lane rural section, which lacks essential amenities like bike lanes and sidewalks. The improvements include:
- Buffered bike lanes on Madison Avenue from 29th Street to the newly constructed roundabout.
- Construction of sidewalks to the east side of the road between Seven Lakes Drive to 37th Street.
- Addition of two way left hand turn lane along Madison Avenue and left turn lane to Seven Lakes Drive.
- A new roundabout at Madison Avenue and 37th Street with crosswalks and buffered bike lanes.
- Additional art piece of a dandelion to Loveland’s 500+ sculptures by Loveland artist Karen Cusolito. Approved by Art in Public Places, as well as funded by the organization.
To limit public disturbances and costs, the Public Works and Utilities Departments will complete the roadway and utility improvements at the same time to lessen disruptions. The project addresses bicycle and pedestrian improvements, relocation of utilities and improvements to overhead powerlines within the corridor that have reached their lifespan.
Project Vision
To transform Madison Avenue into a safe, efficient, and multimodal corridor that enhances connectivity, improves accessibility, and supports Loveland’s long-term multimodal transportation goals. This project will upgrade infrastructure, add bike lanes and sidewalks, improve utilities, and enhance traffic flow—creating a more sustainable and inclusive transportation network for all.
Project Impacts
By early July, the City of Loveland aims to begin construction, starting with underground water and stormwater utility improvements. Once infrastructure improvements are complete, the City of Loveland will focus on surface improvements determined by the streetscape design. Between utility and streetscape improvements, the project is anticipated to take six to eight months to construct.
The intersection of Madison and 37th will be closed while the roundabout is constructed at the intersection. To facilitate detour efficiency, the intersection of 33rd and Monroe Avenue has been converted into a two-way stop from a four-way stop to accommodate the detour traffic.
Project Goals
- Offer improved safety and transportation options for people whether they are driving, walking, or biking.
- Focus on modes of travel – making improvements to travel lanes, bike lanes and sidewalks along the corridor.
- Upgrades to improve safety at the intersections and along the corridor
- Improved connectivity to US Highway 287 and beyond to Taft Avenue.
- Effective use of City funds – combine and coordinate roadway and utility improvements and relocations to lessen public disruption.
Project Funding
- 2019-2024 General Fund = 20%
- 2019-2024 Capital Expansion Fees (CEF) = 80%
- Appropriations of funds for the project began in 2019.
- Design services for the project were completed in 2021.
- Contracted for the project awarded in April 2021.
- Contractor awarded for the project in May 2025.
Stay Informed
To stay informed about this project, subscribe to our email list in the "Stay Informed" section. We understand construction can cause disruptions. If you have a question about the project or would like to contact the project team, email PublicWorksInfo@cityofloveland.org or call 970-962-3669. Please allow us to respond to your requests within 24-48 hours. You may also add your question or comment in the "Questions and Answers" section. Thank you for your patience while this work is being completed.
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project updates 11/10/2025 - 11/14/2025
Share Weekly project updates 11/10/2025 - 11/14/2025 on Facebook Share Weekly project updates 11/10/2025 - 11/14/2025 on Twitter Share Weekly project updates 11/10/2025 - 11/14/2025 on Linkedin Email Weekly project updates 11/10/2025 - 11/14/2025 linkHello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (November 17 – November 21):
- Cement treatment of the subgrade on Madison Avenue has been completed
- The base was laid for curb and gutter
Looking ahead:
- Base will be laid for Madison Avenue's roadway
- Stringline of concrete will be completed
- Concrete curb and gutter will be poured by the equipment
- Concrete hand form and pour will be completed in some areas
Please refer to the photos below for a visual update of progress.
Cement subgrade application on Madison Avenue
Cement compaction on Madison AvenueWeather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
Hello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (November 17 – November 21):
- Cement treatment of the subgrade on Madison Avenue has been completed
- The base was laid for curb and gutter
Looking ahead:
- Base will be laid for Madison Avenue's roadway
- Stringline of concrete will be completed
- Concrete curb and gutter will be poured by the equipment
- Concrete hand form and pour will be completed in some areas
Please refer to the photos below for a visual update of progress.
Cement subgrade application on Madison Avenue
Cement compaction on Madison AvenueWeather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project updates 11/3/2025 - 11/7/2025
Share Weekly project updates 11/3/2025 - 11/7/2025 on Facebook Share Weekly project updates 11/3/2025 - 11/7/2025 on Twitter Share Weekly project updates 11/3/2025 - 11/7/2025 on Linkedin Email Weekly project updates 11/3/2025 - 11/7/2025 linkHello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (November 10 – November 14):
- The final stormwater culvert was completed
- Roadway fill and grading are continuing
- Asphalt has been removed near 29th Street
- Concrete has been removed near along the project
- Subgrade preparation has been completed
Looking ahead:
- Cement treatment of subgrade will be completed
- This will save money and time instead of exchanging soil
- While we're completing this treatment, dust clouds are likely to occur and we encourage neighbors in the surrounding area to keep their windows, garages and doors closed until the end of the week. If questions arise, please call the project hotline at 970-962-3669.
- Road base will be laid
- Road base will be graded in preparation of asphalt placement
Please refer to the photos below for a visual update of progress.
Final culvert installation on Madison Avenue
Asphalt removal near 29th Street and Madison Avenue Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
Hello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (November 10 – November 14):
- The final stormwater culvert was completed
- Roadway fill and grading are continuing
- Asphalt has been removed near 29th Street
- Concrete has been removed near along the project
- Subgrade preparation has been completed
Looking ahead:
- Cement treatment of subgrade will be completed
- This will save money and time instead of exchanging soil
- While we're completing this treatment, dust clouds are likely to occur and we encourage neighbors in the surrounding area to keep their windows, garages and doors closed until the end of the week. If questions arise, please call the project hotline at 970-962-3669.
- Road base will be laid
- Road base will be graded in preparation of asphalt placement
Please refer to the photos below for a visual update of progress.
Final culvert installation on Madison Avenue
Asphalt removal near 29th Street and Madison Avenue Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project updates 10/27/2025 - 10/31/2025
Share Weekly project updates 10/27/2025 - 10/31/2025 on Facebook Share Weekly project updates 10/27/2025 - 10/31/2025 on Twitter Share Weekly project updates 10/27/2025 - 10/31/2025 on Linkedin Email Weekly project updates 10/27/2025 - 10/31/2025 linkHello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (November 3 – November 7):
- One stormwater culvert was completed
- Stormwater inlets were formed and poured
- Sanitary sewer upgrades were completed
Looking ahead:
- One final stormwater culvert will be placed
- Roadway fill and grading will continue On Madison Avenue
- Asphalt will be removed near 29th Street
- Concrete will be removed near 29th Street
- Preparation will continue for cement treatment of subgrade
Please refer to the photos below for a visual update of progress.
Stormwater lid installation placement
Sanitary sewer excavation on Madison Avenue Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org(External link). Thank you for your patience as we complete these improvements!
Hello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (November 3 – November 7):
- One stormwater culvert was completed
- Stormwater inlets were formed and poured
- Sanitary sewer upgrades were completed
Looking ahead:
- One final stormwater culvert will be placed
- Roadway fill and grading will continue On Madison Avenue
- Asphalt will be removed near 29th Street
- Concrete will be removed near 29th Street
- Preparation will continue for cement treatment of subgrade
Please refer to the photos below for a visual update of progress.
Stormwater lid installation placement
Sanitary sewer excavation on Madison Avenue Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org(External link). Thank you for your patience as we complete these improvements!
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project updates 10/20/2025 - 10/24/2025
Share Weekly project updates 10/20/2025 - 10/24/2025 on Facebook Share Weekly project updates 10/20/2025 - 10/24/2025 on Twitter Share Weekly project updates 10/20/2025 - 10/24/2025 on Linkedin Email Weekly project updates 10/20/2025 - 10/24/2025 linkHello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (October 27 – October 31):
- Stormwater installation has continued up towards Seven Lakes Drive
- Comcast has relocated their lines
- Utility poles have been removed
Looking ahead:
- Stormwater culverts will be placed
- Stormwater inlets will be formed and poured
- Sanitary sewer upgrades will be completed
Please refer to the photos below for a visual update of progress.
Stormwater manhole placement on Madison Avenue
Stormwater inlet tie-in on Madison Avenue Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
Hello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (October 27 – October 31):
- Stormwater installation has continued up towards Seven Lakes Drive
- Comcast has relocated their lines
- Utility poles have been removed
Looking ahead:
- Stormwater culverts will be placed
- Stormwater inlets will be formed and poured
- Sanitary sewer upgrades will be completed
Please refer to the photos below for a visual update of progress.
Stormwater manhole placement on Madison Avenue
Stormwater inlet tie-in on Madison Avenue Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project updates 10/13/2025 - 10/17/2025
Share Weekly project updates 10/13/2025 - 10/17/2025 on Facebook Share Weekly project updates 10/13/2025 - 10/17/2025 on Twitter Share Weekly project updates 10/13/2025 - 10/17/2025 on Linkedin Email Weekly project updates 10/13/2025 - 10/17/2025 linkHello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (October 20 – October 24):
- Stormwater installation has continued near Hem Fir
- Power vault at 29th Street and Madison Avenue has been relocated
Looking ahead:
- Stormwater installation will continue northward
- Comcast will continue relocating lines
- Utility poles will begin being removed
Please refer to the photos below for a visual update of progress.
New utility vault being placed on 29th Street and Madison Avenue.
Stormwater infrastructure being installed near Hem Fir on Madison Avenue. Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
Hello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (October 20 – October 24):
- Stormwater installation has continued near Hem Fir
- Power vault at 29th Street and Madison Avenue has been relocated
Looking ahead:
- Stormwater installation will continue northward
- Comcast will continue relocating lines
- Utility poles will begin being removed
Please refer to the photos below for a visual update of progress.
New utility vault being placed on 29th Street and Madison Avenue.
Stormwater infrastructure being installed near Hem Fir on Madison Avenue. Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project update 10/6/2025 - 10/10/2025
Share Weekly project update 10/6/2025 - 10/10/2025 on Facebook Share Weekly project update 10/6/2025 - 10/10/2025 on Twitter Share Weekly project update 10/6/2025 - 10/10/2025 on Linkedin Email Weekly project update 10/6/2025 - 10/10/2025 linkHello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (October 13 – October 17):
- Traffic signal updates on 29th Street and Madison Avenue have been completed
- Waterline updates have been completed
- Installation of waterline board insulation has been completed

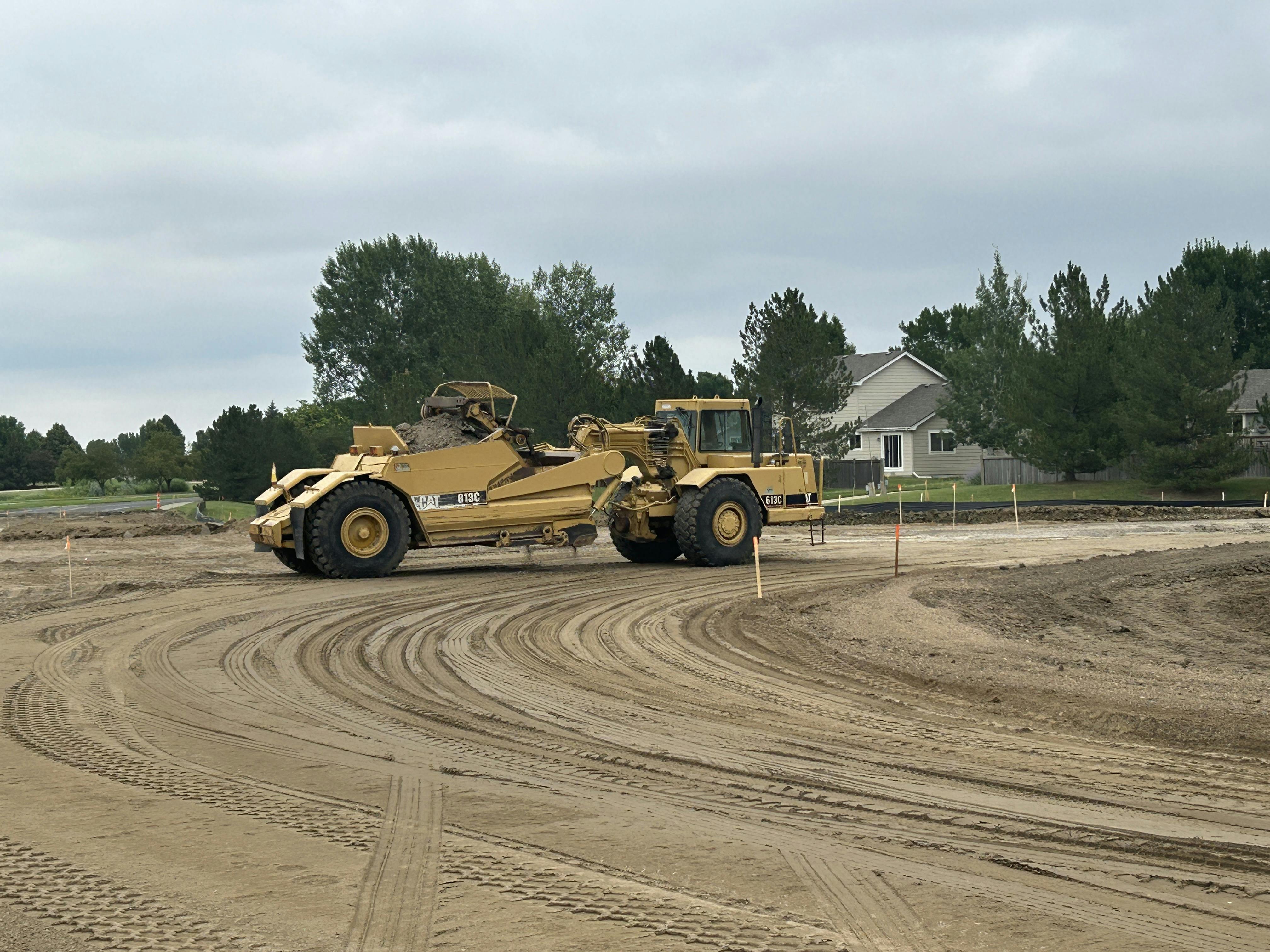

- Stormwater updates are beginning near Hem Fir
- Power continued to be relocated
- Comcast has been relocated under 29th Street
Looking ahead:
- Stormwater installation will continue near Hem Fir
- Installation of pedestrian push buttons at 29th Street and Madison Avenue
- Power vault will be relocated on 29th Street and Madison Avenue
- Cement treatment may begin on Madison Avenue
Monroe Bridge County Project:
- Larimer County will be completing a bridge replacement over Dry Creek with estimated construction starting in November 2025.
- For more information and for any questions, please see Larimer County’s website at https://www.larimer.gov/engineering/project-status-reports/project-no-341-monroe-avenue-bridge-replacement-over-dry-creek
Please refer to the photos below for a visual update of progress.

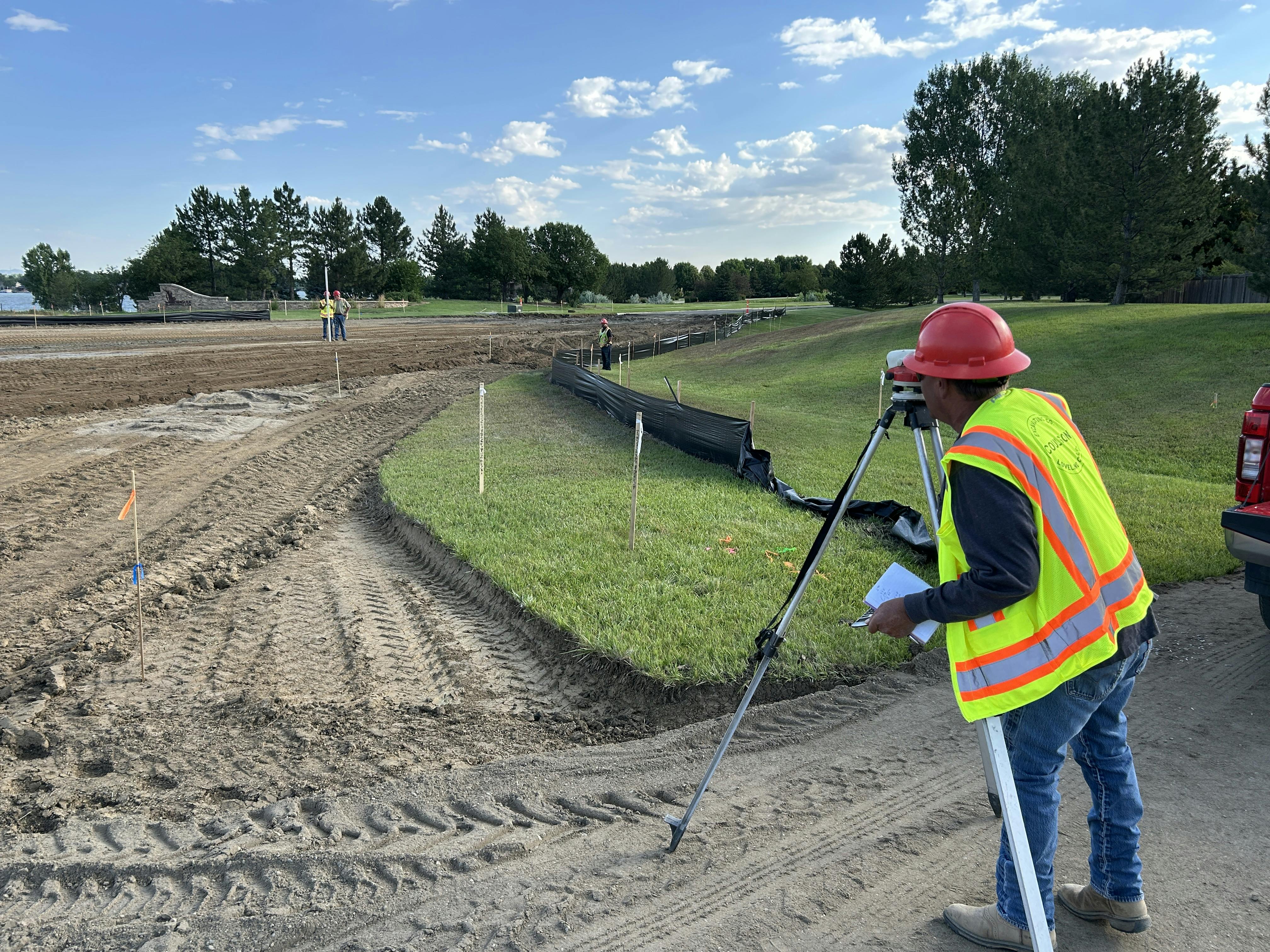

Stormwater materials off in the distance being prepared for installation.
Waterline installation on Madison Avenue Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
Hello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (October 13 – October 17):
- Traffic signal updates on 29th Street and Madison Avenue have been completed
- Waterline updates have been completed
- Installation of waterline board insulation has been completed
- Stormwater updates are beginning near Hem Fir
- Power continued to be relocated
- Comcast has been relocated under 29th Street
Looking ahead:
- Stormwater installation will continue near Hem Fir
- Installation of pedestrian push buttons at 29th Street and Madison Avenue
- Power vault will be relocated on 29th Street and Madison Avenue
- Cement treatment may begin on Madison Avenue
Monroe Bridge County Project:
- Larimer County will be completing a bridge replacement over Dry Creek with estimated construction starting in November 2025.
- For more information and for any questions, please see Larimer County’s website at https://www.larimer.gov/engineering/project-status-reports/project-no-341-monroe-avenue-bridge-replacement-over-dry-creek
Please refer to the photos below for a visual update of progress.
Stormwater materials off in the distance being prepared for installation.
Waterline installation on Madison Avenue Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project update 9/29/2025 - 10/03/2025
Share Weekly project update 9/29/2025 - 10/03/2025 on Facebook Share Weekly project update 9/29/2025 - 10/03/2025 on Twitter Share Weekly project update 9/29/2025 - 10/03/2025 on Linkedin Email Weekly project update 9/29/2025 - 10/03/2025 linkHello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (October 6 – October 10):
- Subgrade and fill have continued on Madison between 29th and 37th Streets
- Traffic signal updates on 29th and Madison have continued
- Water hydrants have been replaced
- Installation of waterline board insulation
- Stormwater updates are beginning
- Electrical utilities continue to be relocated
Looking ahead:
- Waterline updates should wrap up
- Stormwater installation will begin near Hem Fir
- Comcast relocations will occur under 29th Street
- Traffic signal updates should be completed
- Electrical utility relocations adjacent to 29th Street should be completed
37th Street County Project: Larimer County will be completing a street rehabilitation project by removing the old asphalt on 37th Street between Monroe and Madison Avenues. The road between Monroe and Madison Avenues is owned by Larimer County. For more information about this upcoming work, please see Larimer County’s website at https://www.larimer.gov/roads.
Please refer to the photos below for a visual update of progress.
Installation of 29th Street traffic signal and electrical work.
Hydrant removals were completed and new hydrants were installed on Madison AvenueWeather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
Hello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (October 6 – October 10):
- Subgrade and fill have continued on Madison between 29th and 37th Streets
- Traffic signal updates on 29th and Madison have continued
- Water hydrants have been replaced
- Installation of waterline board insulation
- Stormwater updates are beginning
- Electrical utilities continue to be relocated
Looking ahead:
- Waterline updates should wrap up
- Stormwater installation will begin near Hem Fir
- Comcast relocations will occur under 29th Street
- Traffic signal updates should be completed
- Electrical utility relocations adjacent to 29th Street should be completed
37th Street County Project: Larimer County will be completing a street rehabilitation project by removing the old asphalt on 37th Street between Monroe and Madison Avenues. The road between Monroe and Madison Avenues is owned by Larimer County. For more information about this upcoming work, please see Larimer County’s website at https://www.larimer.gov/roads.
Please refer to the photos below for a visual update of progress.
Installation of 29th Street traffic signal and electrical work.
Hydrant removals were completed and new hydrants were installed on Madison AvenueWeather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project updates 9/22/2025 - 9/26/2025
Share Weekly project updates 9/22/2025 - 9/26/2025 on Facebook Share Weekly project updates 9/22/2025 - 9/26/2025 on Twitter Share Weekly project updates 9/22/2025 - 9/26/2025 on Linkedin Email Weekly project updates 9/22/2025 - 9/26/2025 linkHello, Loveland!
Here’s last week's update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned this week (September 29 – October 3):
- Roundabout has been opened to the public
- Stabilization for erosion control applied to banks
- Excavation and asphalt removals continued on Madison

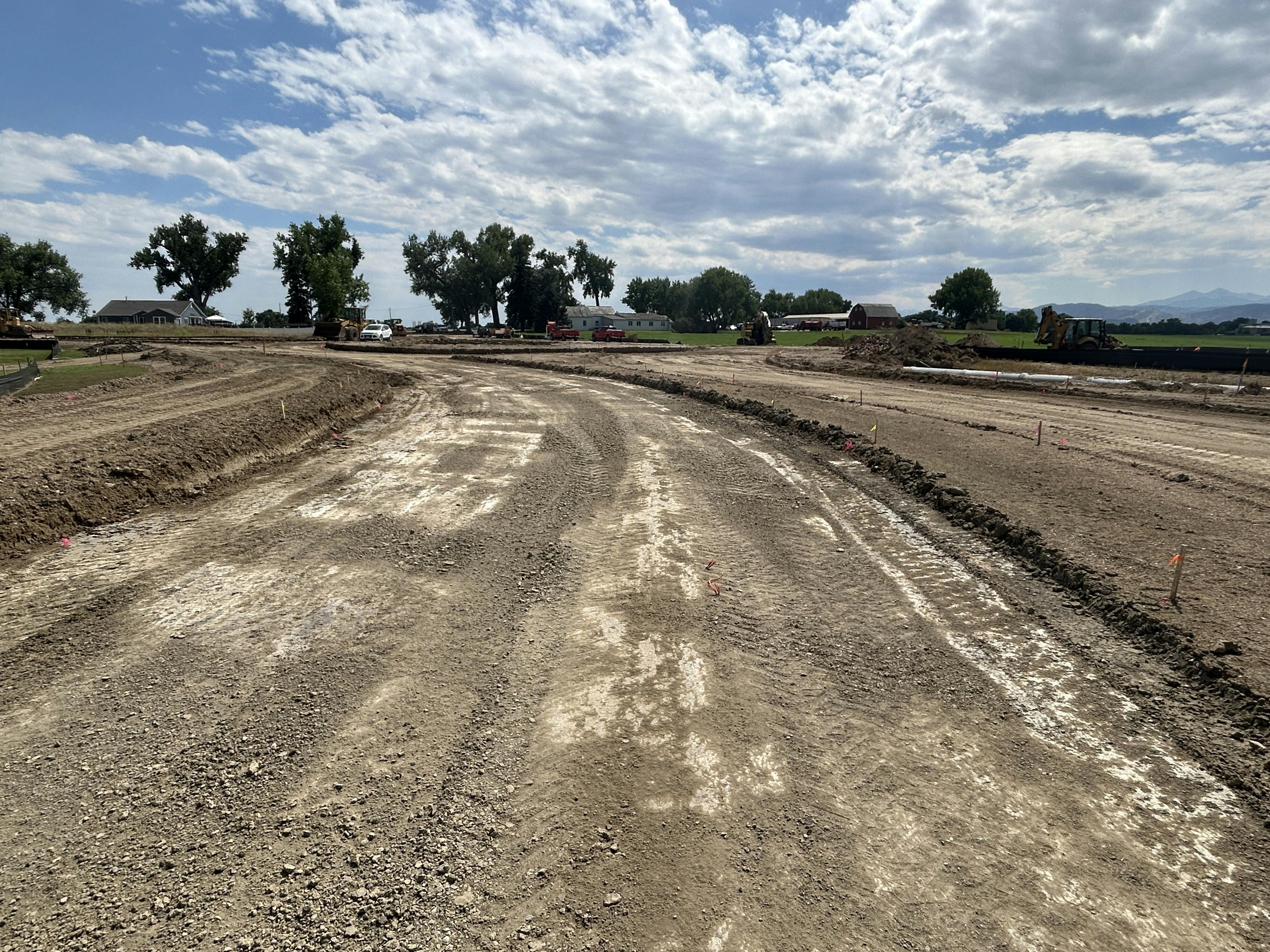

- Waterline work continued near Seven Lakes
Looking ahead:
- Subgrade preparation and fill
- Traffic signal updates on 29th and Madison Avenue
- Waterline updates will continue northward
- Waterline updates near Seven Lakes
- Installation of waterline board insulation
Please refer to the photos below for a visual update of progress.


Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
Hello, Loveland!
Here’s last week's update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned this week (September 29 – October 3):
- Roundabout has been opened to the public
- Stabilization for erosion control applied to banks
- Excavation and asphalt removals continued on Madison
- Waterline work continued near Seven Lakes
Looking ahead:
- Subgrade preparation and fill
- Traffic signal updates on 29th and Madison Avenue
- Waterline updates will continue northward
- Waterline updates near Seven Lakes
- Installation of waterline board insulation
Please refer to the photos below for a visual update of progress.


Weather permitting, work activities are Monday – Friday, 7:00 a.m. – 7:00 p.m. To contact the project team, call 970-962-3669 or email PublicWorksInfo@cityofloveland.org. Thank you for your patience as we complete these improvements!
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Madison Avenue Construction Update - August Recap
Share Madison Avenue Construction Update - August Recap on Facebook Share Madison Avenue Construction Update - August Recap on Twitter Share Madison Avenue Construction Update - August Recap on Linkedin Email Madison Avenue Construction Update - August Recap linkMadison Avenue Construction Update – August Recap
Throughout August, construction for the Madison Avenue Corridor Improvement Project moved forward with several key milestones.
- During the week of August 4–8, crews poured the curb and gutter concrete along the outer edges of the roundabout and installed the median islands. A section of Madison Avenue was removed to begin lowering 350 feet of waterline in preparation for future work.
- The following week, August 11–15, work continued with additional curb and gutter concrete pours inside the roundabout. Crews lowered the waterline at Hem Fir Place, while grading progressed for new sidewalk sections along the northeast corner. Preparations began to place median cover material, and sidewalk concrete was poured around the roundabout.
- From August 18–25, the waterline lowering advanced north of Hem Fir Place. Grading and sidewalk construction remained a focus, with crews continuing to pour new sidewalk concrete around the roundabout.
- Finally, during the week of August 25–29, the concrete pavement around the roundabout was completed and asphalt paving began at the roundabout entrances, marking an important step toward the project’s completion.

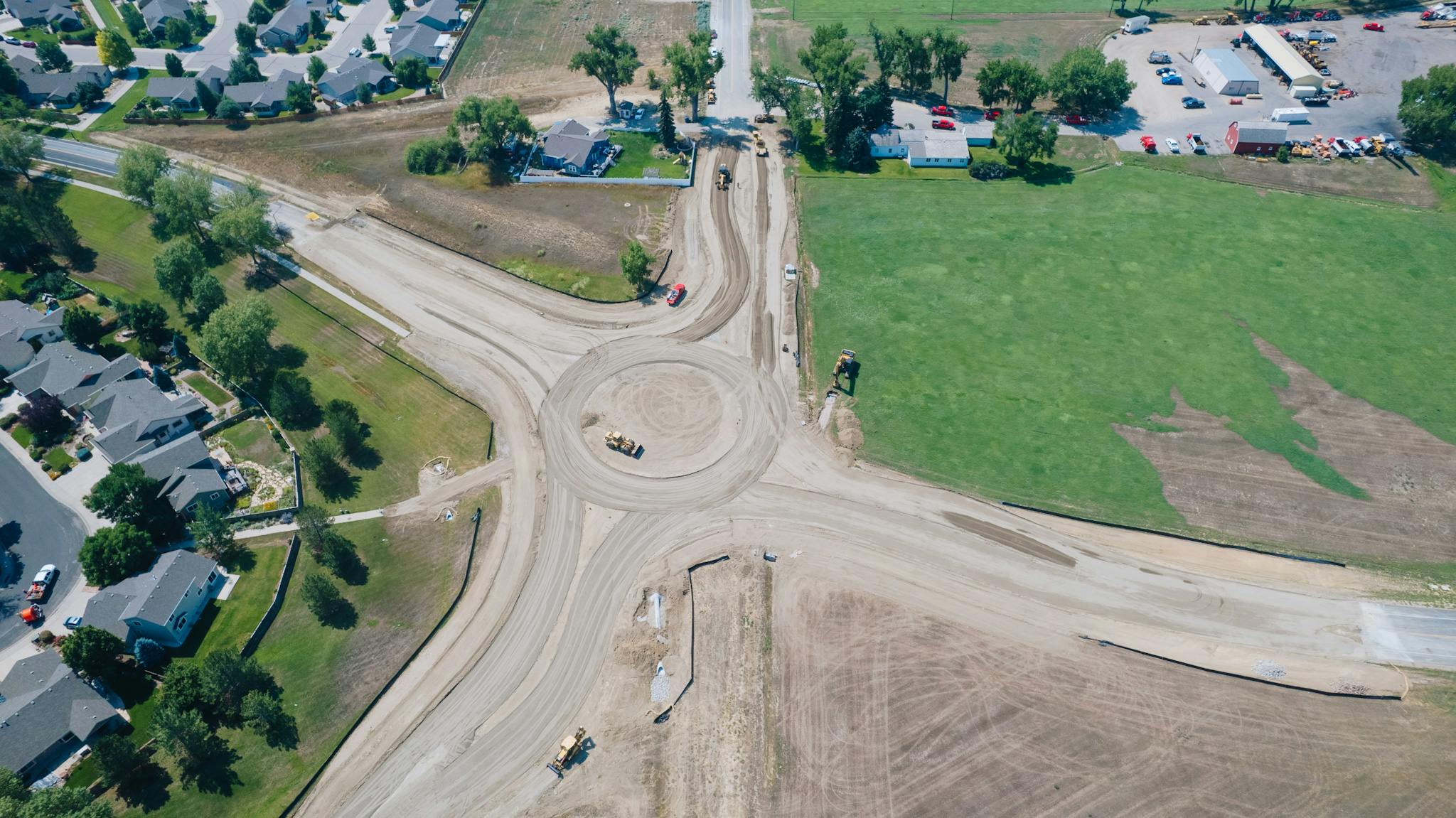

37th Street roundabout open for traffic
The project team is pleased to announce that the 37th Street roundabout is officially opened to drivers, pedestrians and cyclists. Madison Avenue, however, remains fully closed between 29th Street and 37th Street and will continue to be under full closure until the project is completed at the end of the year. During this time, crews will continue with utility upgrades, road and sidewalk connectivity improvements. With the roundabout now open, traffic may travel along 37th Street from either Boise or Monroe Avenues, and Seeley Drive is also accessible to the nearing neighborhood.
A sculpture of a dandelion will be installed in October at the center of the roundabout by Art in Public Places and the remaining landscape near the roundabout will be installed in spring 2026. The sculptor is fully funded by Art in Public Places.
Before construction started at the Madison Avenue and 37th Street intersection in July 2025.
During construction for the roundabout in August 2025. Construction completed for the roundabout in September 2025.
Safety during construction
As construction continues along Madison Avenue, the road remains an active construction zone. While the site roundabout is partially finished, the project team urges pedestrians, cyclists and commuters to remain vigilant of posted signage and not to enter the active worksite if they are not an adjacent property owner.
Traffic and Detours:
Madison Avenue remains closed between 29th and 37th Streets. Local access to Madison Avenue is only available for those who live or own property along Madison Avenue between 29th and 37th Streets. Commuters outside the construction limits should follow the designated detour routes by using the following streets:
- North Boise Avenue
- Monroe Avenue
- 29th Street
- 37th Street
- US 34
For project updates or to stay up to date on weekly progress, visit go.lovgov.org/Madison Avenue. The project is anticipated to be fully completed by December 2025, weather permitting. Residents who wish to sign up for the project newsletter or contact the project team can email PublicWorksInfo@cityofloveland.org or call 970-962-3669.
An updated detour map for September 19, 2025. About
The Madison Avenue Corridor Improvement Project aims to improve safety, mobility, and infrastructure along a vital north-south route between 29th and 37th Streets. As one of the city’s most traveled corridors, Madison Avenue connects neighborhoods, schools, parks, and major arterials, including US 287. This project will modernize the corridor by adding buffered bike lanes, new sidewalks, and a new roundabout at 37th Street—all designed to support safer travel for drivers, pedestrians, and cyclists alike. In addition to improving traffic flow, the project will add a feature of public art by Art in Public Places. Construction is expected to be completed by December 2025.
Project Funding
The Madison Avenue Corridor Improvement Project is funded through a combination of the City of Loveland’s General Fund and Capital Expansion Fees (CEFs). From 2019 to 2024, approximately 20% of the project funding came from the General Fund, while the remaining 80% was provided through CEFs. Appropriations for the project began in 2019, with design services completed in 2021. The construction contract was awarded in May 2025, following a competitive bidding process.
Madison Avenue Construction Update – August Recap
Throughout August, construction for the Madison Avenue Corridor Improvement Project moved forward with several key milestones.
- During the week of August 4–8, crews poured the curb and gutter concrete along the outer edges of the roundabout and installed the median islands. A section of Madison Avenue was removed to begin lowering 350 feet of waterline in preparation for future work.
- The following week, August 11–15, work continued with additional curb and gutter concrete pours inside the roundabout. Crews lowered the waterline at Hem Fir Place, while grading progressed for new sidewalk sections along the northeast corner. Preparations began to place median cover material, and sidewalk concrete was poured around the roundabout.
- From August 18–25, the waterline lowering advanced north of Hem Fir Place. Grading and sidewalk construction remained a focus, with crews continuing to pour new sidewalk concrete around the roundabout.
- Finally, during the week of August 25–29, the concrete pavement around the roundabout was completed and asphalt paving began at the roundabout entrances, marking an important step toward the project’s completion.
37th Street roundabout open for traffic
The project team is pleased to announce that the 37th Street roundabout is officially opened to drivers, pedestrians and cyclists. Madison Avenue, however, remains fully closed between 29th Street and 37th Street and will continue to be under full closure until the project is completed at the end of the year. During this time, crews will continue with utility upgrades, road and sidewalk connectivity improvements. With the roundabout now open, traffic may travel along 37th Street from either Boise or Monroe Avenues, and Seeley Drive is also accessible to the nearing neighborhood.
A sculpture of a dandelion will be installed in October at the center of the roundabout by Art in Public Places and the remaining landscape near the roundabout will be installed in spring 2026. The sculptor is fully funded by Art in Public Places.
Before construction started at the Madison Avenue and 37th Street intersection in July 2025.
During construction for the roundabout in August 2025. Construction completed for the roundabout in September 2025.
Safety during construction
As construction continues along Madison Avenue, the road remains an active construction zone. While the site roundabout is partially finished, the project team urges pedestrians, cyclists and commuters to remain vigilant of posted signage and not to enter the active worksite if they are not an adjacent property owner.
Traffic and Detours:
Madison Avenue remains closed between 29th and 37th Streets. Local access to Madison Avenue is only available for those who live or own property along Madison Avenue between 29th and 37th Streets. Commuters outside the construction limits should follow the designated detour routes by using the following streets:
- North Boise Avenue
- Monroe Avenue
- 29th Street
- 37th Street
- US 34
For project updates or to stay up to date on weekly progress, visit go.lovgov.org/Madison Avenue. The project is anticipated to be fully completed by December 2025, weather permitting. Residents who wish to sign up for the project newsletter or contact the project team can email PublicWorksInfo@cityofloveland.org or call 970-962-3669.
An updated detour map for September 19, 2025. About
The Madison Avenue Corridor Improvement Project aims to improve safety, mobility, and infrastructure along a vital north-south route between 29th and 37th Streets. As one of the city’s most traveled corridors, Madison Avenue connects neighborhoods, schools, parks, and major arterials, including US 287. This project will modernize the corridor by adding buffered bike lanes, new sidewalks, and a new roundabout at 37th Street—all designed to support safer travel for drivers, pedestrians, and cyclists alike. In addition to improving traffic flow, the project will add a feature of public art by Art in Public Places. Construction is expected to be completed by December 2025.
Project Funding
The Madison Avenue Corridor Improvement Project is funded through a combination of the City of Loveland’s General Fund and Capital Expansion Fees (CEFs). From 2019 to 2024, approximately 20% of the project funding came from the General Fund, while the remaining 80% was provided through CEFs. Appropriations for the project began in 2019, with design services completed in 2021. The construction contract was awarded in May 2025, following a competitive bidding process.
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
-
Weekly project updates 9/8/2025 - 9/12/2025
Share Weekly project updates 9/8/2025 - 9/12/2025 on Facebook Share Weekly project updates 9/8/2025 - 9/12/2025 on Twitter Share Weekly project updates 9/8/2025 - 9/12/2025 on Linkedin Email Weekly project updates 9/8/2025 - 9/12/2025 linkHello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (September 8 – September 12):
- Madison has been milled from 37th Street to Seven Lakes Drive.
- Median cover material has been completed.
- Waterline updates are continuing north on Madison Avenue.
- Sidewalk continues to be poured around the roundabout.
- Final grading continues for stabilization.
Looking ahead:
- Top lift of asphalt on the west, north, and east legs of the roundabout
- Roadway grading along the milled section on Madison Avenue
- Waterline updates will continue north on Madison Avenue.
- Sidewalk will continue to be poured around the roundabout.
- Power, Pulse, and Comcast utility relocations continue south of Seven Lakes Dr.
Please refer to the photos below for a visual update of progress.
Light poles are installed around the roundabout.Cassions are installed at the southwest corner of the roundabout.
Hello, Loveland!
Here’s this week’s update from the Madison Avenue Corridor Improvement Project, along with a look ahead at what’s planned for next week (September 8 – September 12):
- Madison has been milled from 37th Street to Seven Lakes Drive.
- Median cover material has been completed.
- Waterline updates are continuing north on Madison Avenue.
- Sidewalk continues to be poured around the roundabout.
- Final grading continues for stabilization.
Looking ahead:
- Top lift of asphalt on the west, north, and east legs of the roundabout
- Roadway grading along the milled section on Madison Avenue
- Waterline updates will continue north on Madison Avenue.
- Sidewalk will continue to be poured around the roundabout.
- Power, Pulse, and Comcast utility relocations continue south of Seven Lakes Dr.
Please refer to the photos below for a visual update of progress.
Light poles are installed around the roundabout.Cassions are installed at the southwest corner of the roundabout.
As of April 30, 2026, construction of this project is complete! Thank you for your patience during these critical upgrades. Read the news about the completion.
For questions, contact the Public Works Department at 970-962-2524 or email: PublicWorksInfo@cityofloveland.org.
Key Dates
-
June 16 2025
-
July 07 2025
-
December 2025
-
April 06 2026
-
April 2026
Videos
-
Click here to play video
Madison Avenue Corridor Improvement Project - September Milestone
Loveland, the Madison Avenue Corridor Improvement Project has just completed a huge project milestone! The roundabout is now open for commuting traffic, pedestrians and cyclists. Although the roundabout is open to traffic on 37th Street between Boise and Monroe Avenues, Madison Avenue is still under a full closure. The project is slated to be completed by the end of the year while we complete the remaining utility installations, added buffer bike lanes and sidewalk connectivity.
The roundabout includes pedestrian islands, sidewalk connectivity, and an art installation by Art in Public Places that will be installed in October.
Interested in staying in the loop about the project's progress, visit go.lovgov.org/MadisonAvenue.
Lifecycle
-
Project Adoption
Madison Avenue Corridor Improvement Project has finished this stageAdopted in the City’s Transportation Master Plan in 2000.
-
Design
Madison Avenue Corridor Improvement Project has finished this stageFunds were allocated to begin design in 2019, and the design of the project was completed in 2021.
-
Community Outreach
Madison Avenue Corridor Improvement Project has finished this stageInitial community outreach began in 2021 and included presentations at Transportation Advisory Board meetings from 2021 to 2022, as well as booths at various community events in 2022, such as Everybody Bike Day, One Sweet Summer, Friday Night on the Town, and Farmers Market. A Community Open House is scheduled for Monday, June 16, 2025, to inform residents about impacts, construction timelines, and detour routes.
-
Construction Begins
Madison Avenue Corridor Improvement Project has finished this stageConstruction starting, Monday, July 7, the project will close the roadway between 37th to 29th will local access to adjacent residents.
-
Winter Shutdown - December 23, 2025 to March 2026
Madison Avenue Corridor Improvement Project has finished this stageDue to inclement weather looming, the project will temporarily open the road to traffic. In March 2026, the project will add a final layer of asphalt to complete the roadway, as well as seeding and installing the artwork at the roundabout.
-
April
Madison Avenue Corridor Improvement Project has finished this stageMadison closure for top lift of asphalt and concrete work.
-
Project Completed
Madison Avenue Corridor Improvement Project is currently at this stageApril 30, 2026
Who's Listening
-
MA
Phone 970-962-3669 -
Phone 970-962-2740 Email Scott.Kemper@cityofloveland.org -
Phone 970-962-2645 Email Bonar.Crump@cityofloveland.org -
Phone 970-962-3702 Email donald.cecil@cityofloveland.org -
Phone 970-962-2608 Email Illianna.Milldrum@cityofloveland.org
