Namaqua Hills Waterline Replacement

Share Namaqua Hills Waterline Replacement on Facebook Share Namaqua Hills Waterline Replacement on X (formerly Twitter) Share Namaqua Hills Waterline Replacement on Linkedin Email Namaqua Hills Waterline Replacement link

The City of Loveland Utilities Department is replacing aging waterlines in the Namaqua Hills neighborhood to improve water service reliability and reduce frequent breaks. The existing 6‑inch cast‑iron lines were installed in the 1960s and placed directly on bedrock, which shifts over time and has caused repeated failures.

To address this, crews will excavate sections of bedrock and install new 8‑inch PVC waterlines on a sand or gravel base. This foundation will better protect the system and support the community’s water needs well into the future.

Project Impacts

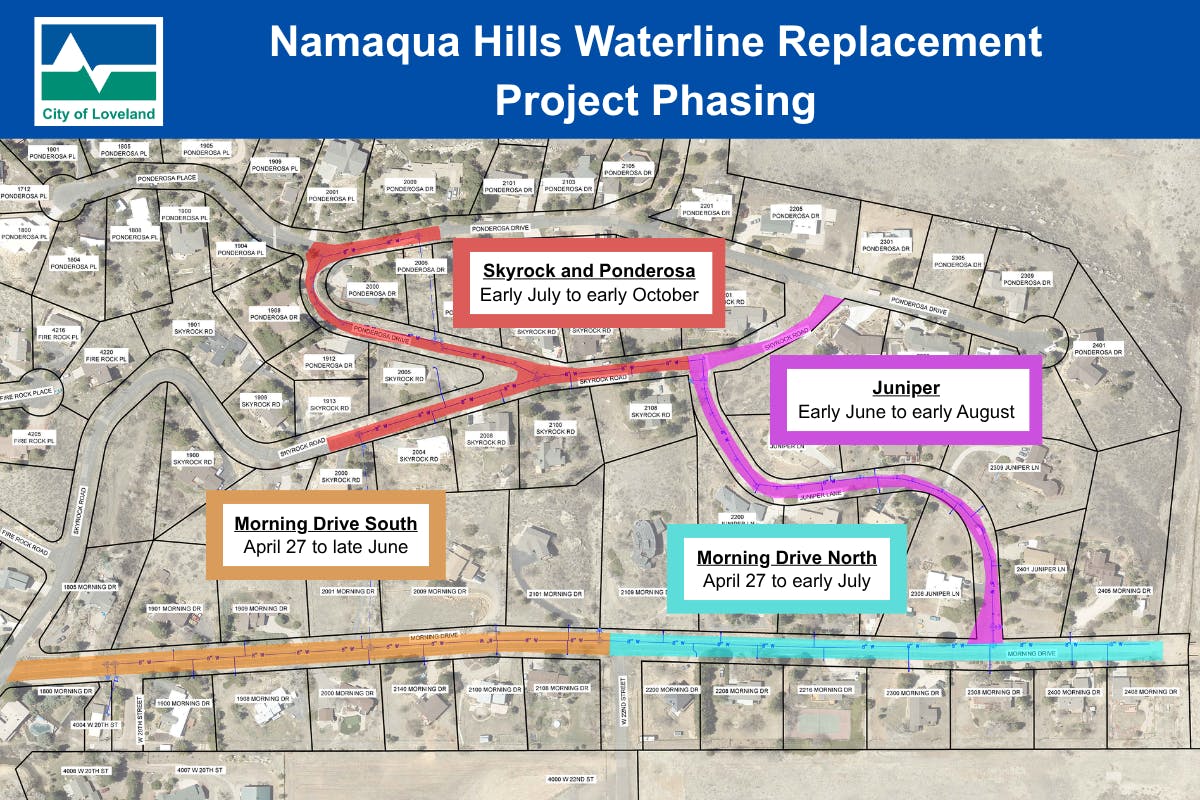

Following inspections, the City identified Morning Drive, Juniper Lane, and parts of Skyrock Road and Ponderosa Drive as priority areas for replacement. Construction will begin April 27 and is expected to continue through October 2026. Work will generally take place Monday through Friday, 7 a.m. to 5 p.m., with occasional Saturdays if needed.

Road closures will occur in phases as work moves through the neighborhood. Local access will remain open, and crews will coordinate to maintain mail, trash, and delivery services. Due to the composition of bedrock and the equipment needed, residents can expect heavy equipment to be staged in the roadway and should expect loud working conditions.

Temporary water service will be used at times throughout the project. Hand-delivered notices will be provided at least 48 hours before any planned outage or transition to temporary service.

Please refer to the project FAQ on the sidebar of this page for answers to common questions and additional details.

Project Funding

The Namaqua Waterline Replacement Project is funded through the Utilities Enterprise Fund. Enterprise funds are dedicated funds supported by user fees in the monthly utility bill. Similar to a business, user fees fund the operation, maintenance, administration, and capital improvement projects required to provide the service.  

For general questions about the City’s budget, visit the Let's Talk Loveland Budget page. 

Stay Informed

We understand construction can cause disruptions. If you have a question about the project, you may also add your questions or comments in the "Questions and Answers" section. Thank you for your patience while this work is completed.

The City of Loveland Utilities Department is replacing aging waterlines in the Namaqua Hills neighborhood to improve water service reliability and reduce frequent breaks. The existing 6‑inch cast‑iron lines were installed in the 1960s and placed directly on bedrock, which shifts over time and has caused repeated failures.

To address this, crews will excavate sections of bedrock and install new 8‑inch PVC waterlines on a sand or gravel base. This foundation will better protect the system and support the community’s water needs well into the future.

Project Impacts

Following inspections, the City identified Morning Drive, Juniper Lane, and parts of Skyrock Road and Ponderosa Drive as priority areas for replacement. Construction will begin April 27 and is expected to continue through October 2026. Work will generally take place Monday through Friday, 7 a.m. to 5 p.m., with occasional Saturdays if needed.

Road closures will occur in phases as work moves through the neighborhood. Local access will remain open, and crews will coordinate to maintain mail, trash, and delivery services. Due to the composition of bedrock and the equipment needed, residents can expect heavy equipment to be staged in the roadway and should expect loud working conditions.

Temporary water service will be used at times throughout the project. Hand-delivered notices will be provided at least 48 hours before any planned outage or transition to temporary service.

Please refer to the project FAQ on the sidebar of this page for answers to common questions and additional details.

Project Funding

The Namaqua Waterline Replacement Project is funded through the Utilities Enterprise Fund. Enterprise funds are dedicated funds supported by user fees in the monthly utility bill. Similar to a business, user fees fund the operation, maintenance, administration, and capital improvement projects required to provide the service.  

For general questions about the City’s budget, visit the Let's Talk Loveland Budget page. 

Stay Informed

We understand construction can cause disruptions. If you have a question about the project, you may also add your questions or comments in the "Questions and Answers" section. Thank you for your patience while this work is completed.

  • Construction Update: July 20 to 31

    Share Construction Update: July 20 to 31 on Facebook Share Construction Update: July 20 to 31 on X (formerly Twitter) Share Construction Update: July 20 to 31 on Linkedin Email Construction Update: July 20 to 31 link

    Hello Loveland!

    Here's the latest update on construction from July 20 to July 31, along with a look ahead at what's coming next.

    Construction Progress

    • Installation of the new 8-inch PVC waterline along Juniper Lane is complete, along with meter pit replacements and service line installations. Disinfection and testing are also complete.
    • Landscape restoration work was active along Morning Drive last week.
    • Build out of temporary water service for Phase 4 is complete, along with disinfection and testing.

    Upcoming Work

    • This week, milling is happening along Juniper Lane to prepare for paving, and along Skyrock Road and Ponderosa Drive to prepare for waterline installation.
    • On Aug. 4, customers in Phase 3 on Juniper Lane will be connected to the new waterline. Customers in Phase 4 will shift to temporary water while crews work in that area.
    • Waterline and meter pit replacement will continue south on Skyrock Road before curving west and north along Ponderosa Drive.

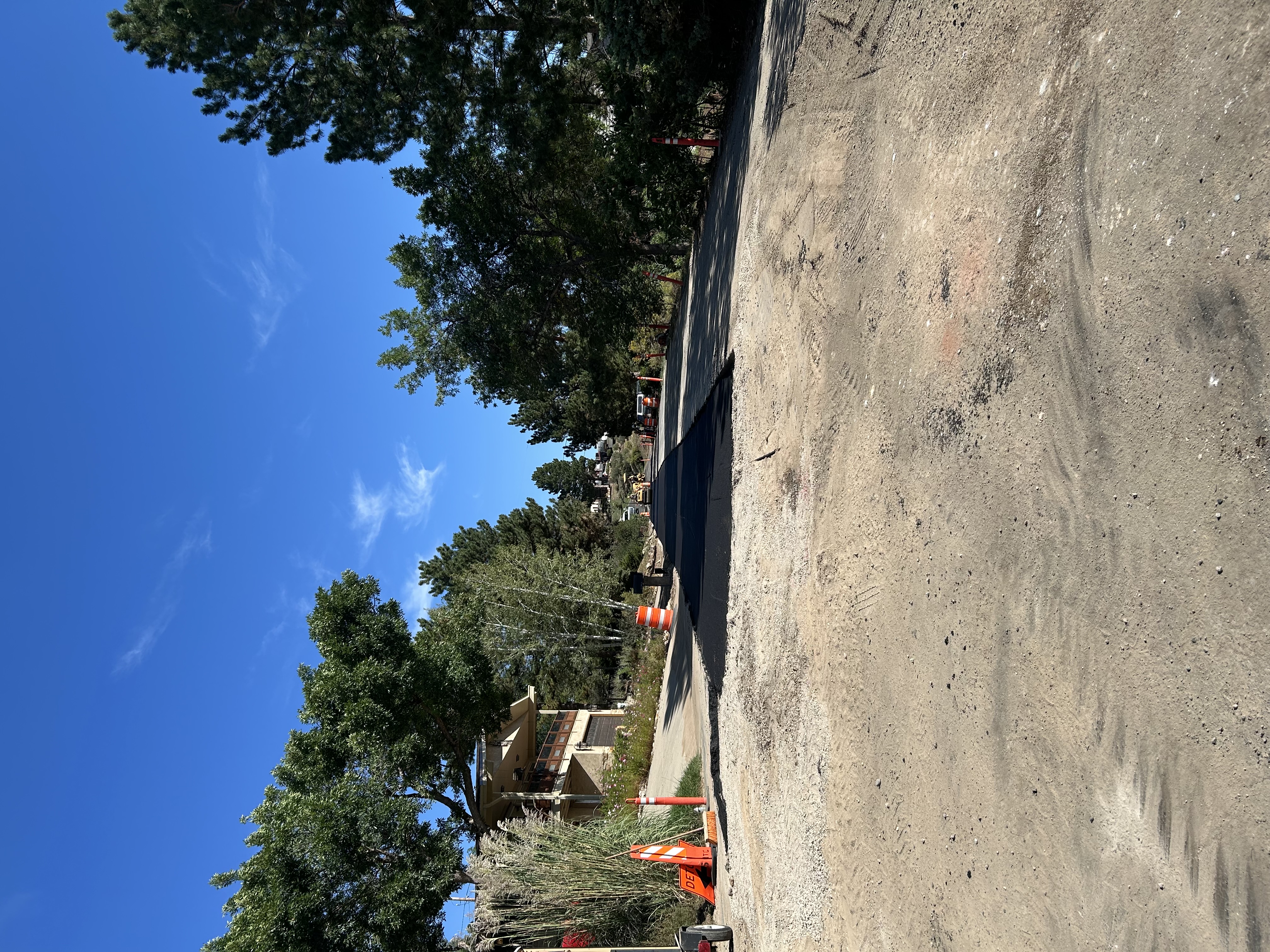

    • Juniper Lane will be paved Aug. 6-7. Landscape restoration will follow in the coming weeks.

    Traffic Control

    • Juniper Lane and a portion of Skyrock Road will be closed to through traffic while paving continues on Juniper Lane.
    • On Aug. 10, Juniper Lane will reopen to through traffic, and sections of Skyrock Road and Ponderosa Lane will close to through traffic as Phase 4 construction continues.
    • Xcel Energy's contractors are still replacing electric poles in the area, which may may cause additional traffic delays or brief obstructions.

    Thank you for your patience as we continue making important improvements to your neighborhood's water system.

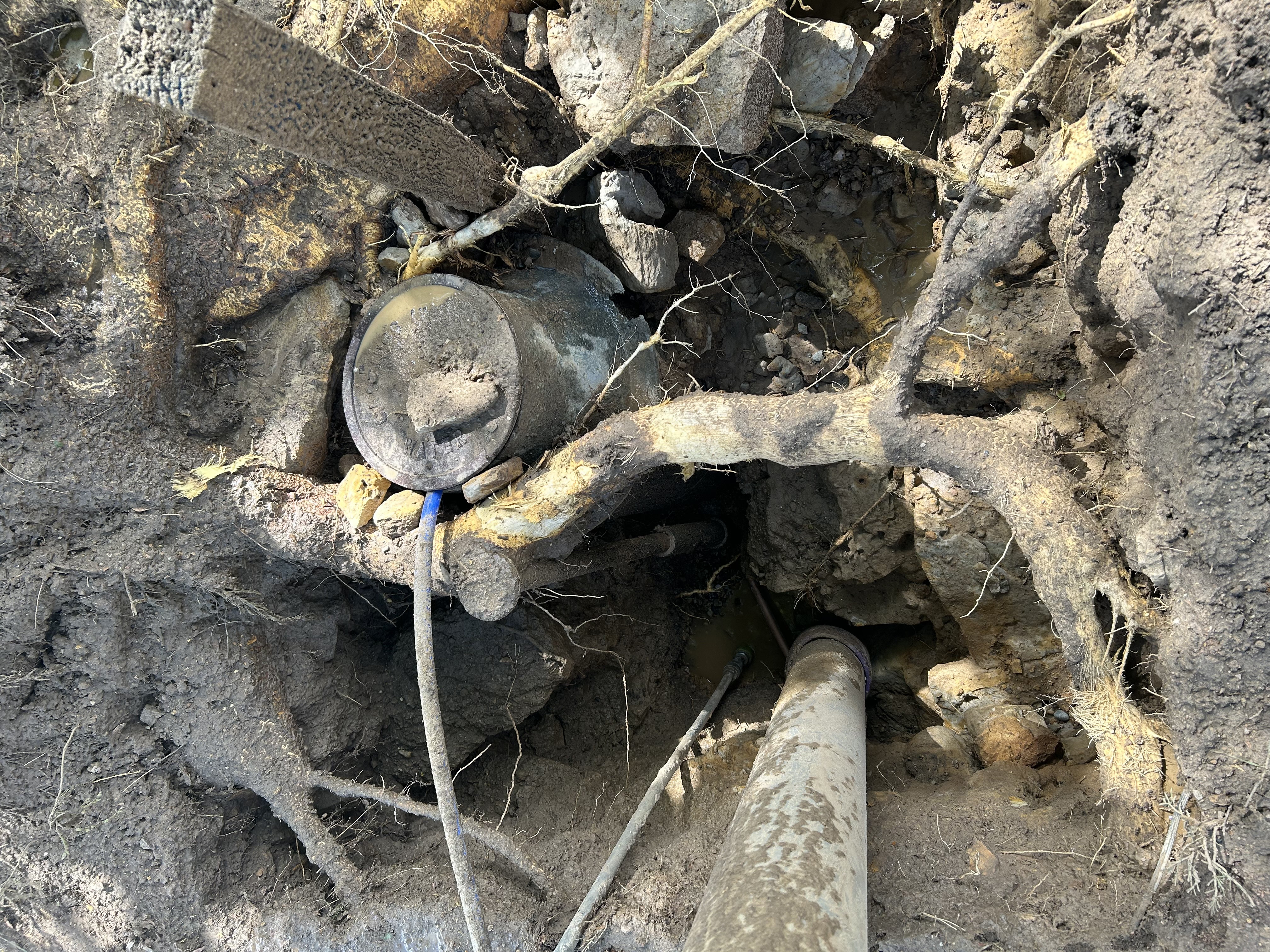

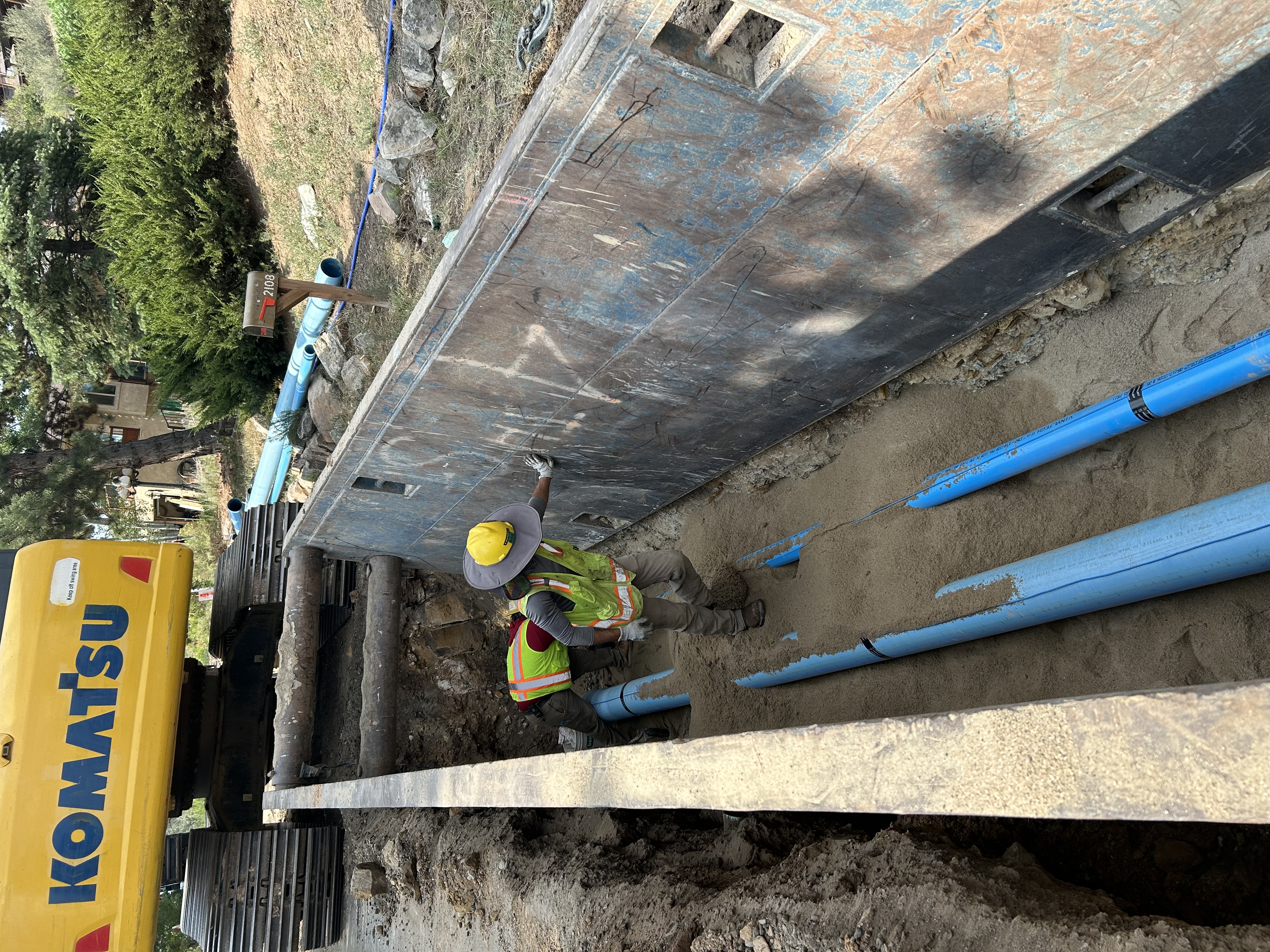

    Existing water meter pit and tree root system intertwine. The finished product of paving and striping work on Morning Drive.

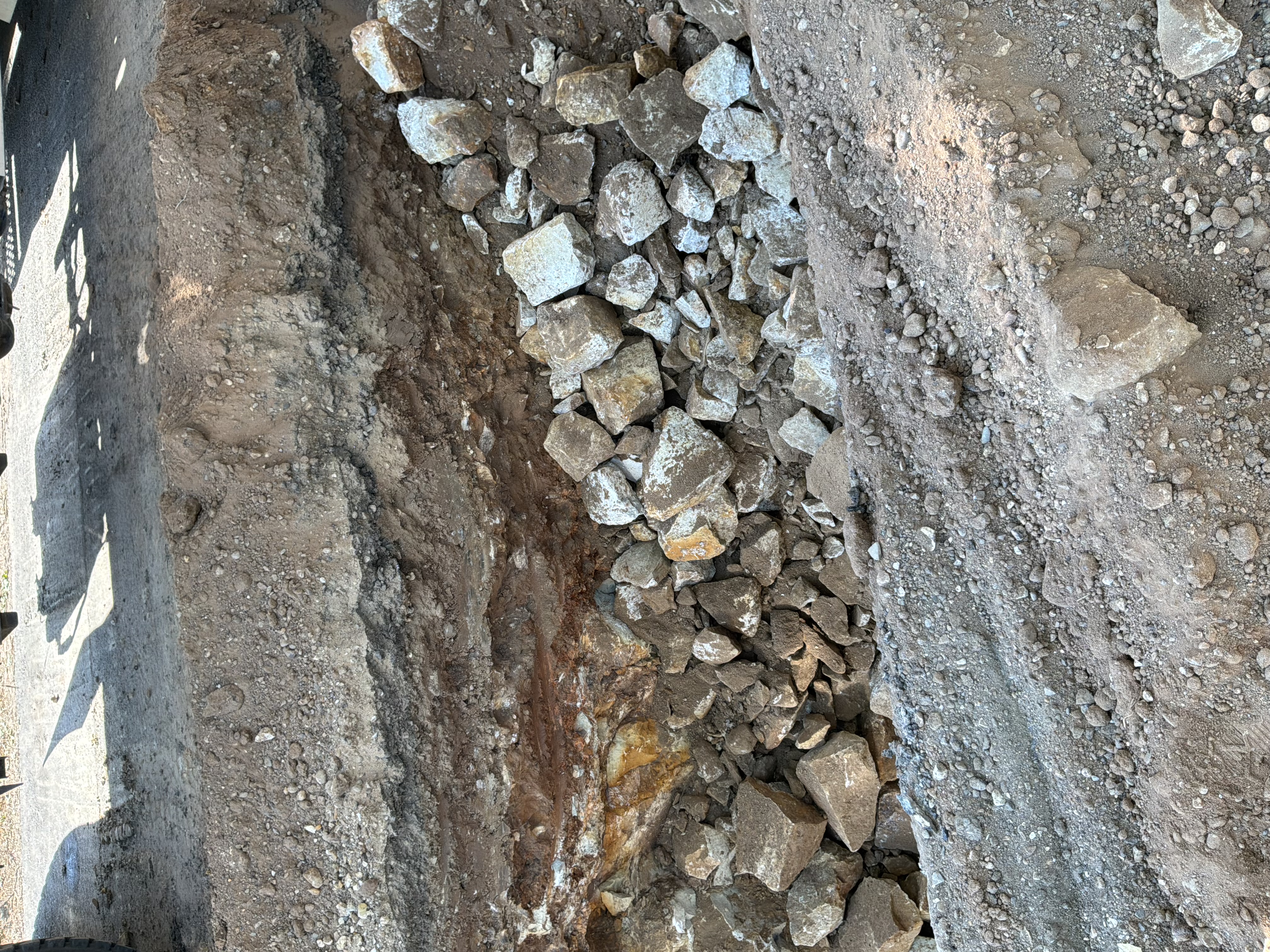

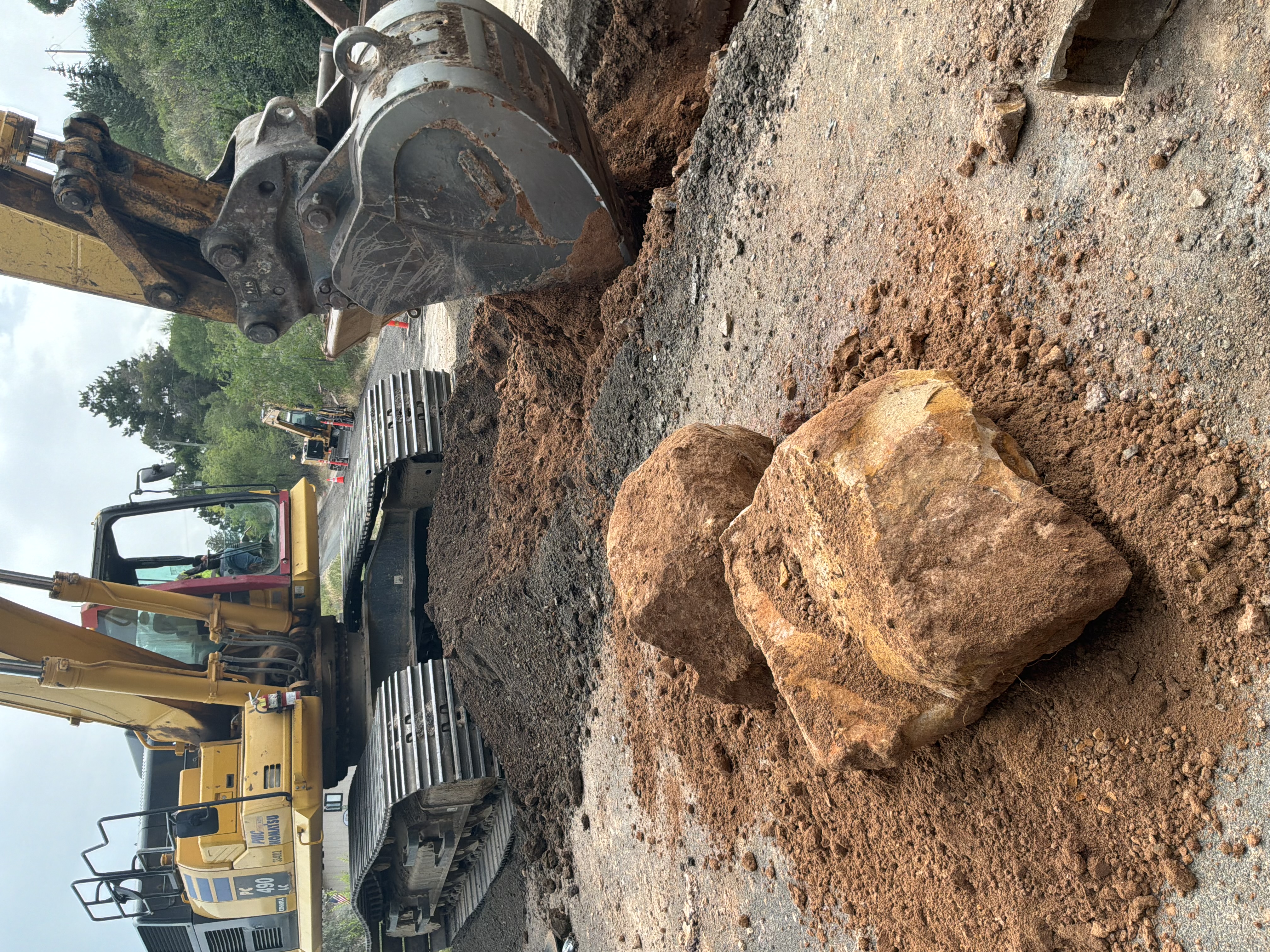

    Rock being removed during excavation.

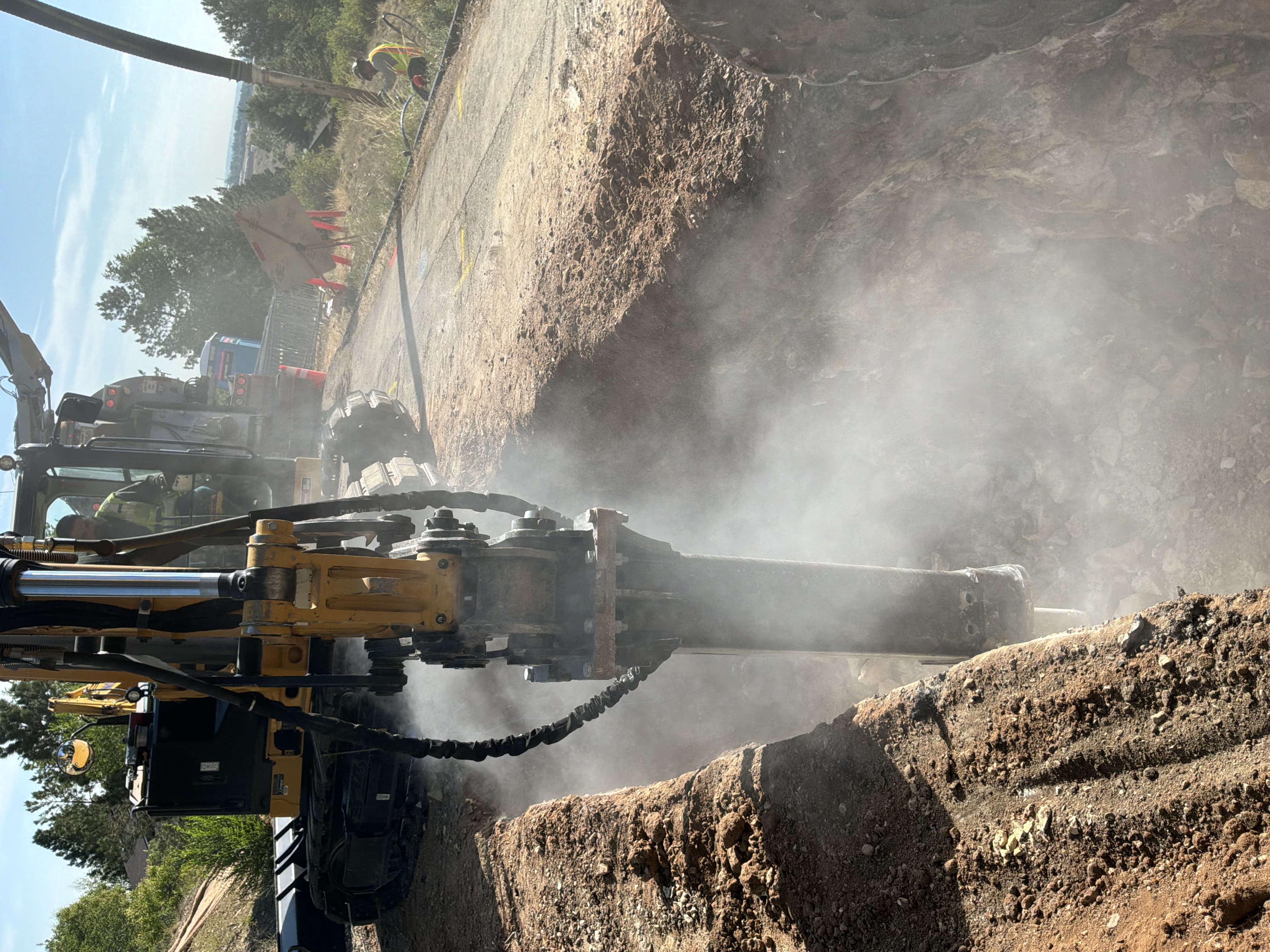

    Breaking up rock using an air hammer on the excavator.

    Hello Loveland!

    Here's the latest update on construction from July 20 to July 31, along with a look ahead at what's coming next.

    Construction Progress

    • Installation of the new 8-inch PVC waterline along Juniper Lane is complete, along with meter pit replacements and service line installations. Disinfection and testing are also complete.
    • Landscape restoration work was active along Morning Drive last week.
    • Build out of temporary water service for Phase 4 is complete, along with disinfection and testing.

    Upcoming Work

    • This week, milling is happening along Juniper Lane to prepare for paving, and along Skyrock Road and Ponderosa Drive to prepare for waterline installation.
    • On Aug. 4, customers in Phase 3 on Juniper Lane will be connected to the new waterline. Customers in Phase 4 will shift to temporary water while crews work in that area.
    • Waterline and meter pit replacement will continue south on Skyrock Road before curving west and north along Ponderosa Drive.
    • Juniper Lane will be paved Aug. 6-7. Landscape restoration will follow in the coming weeks.

    Traffic Control

    • Juniper Lane and a portion of Skyrock Road will be closed to through traffic while paving continues on Juniper Lane.
    • On Aug. 10, Juniper Lane will reopen to through traffic, and sections of Skyrock Road and Ponderosa Lane will close to through traffic as Phase 4 construction continues.
    • Xcel Energy's contractors are still replacing electric poles in the area, which may may cause additional traffic delays or brief obstructions.

    Thank you for your patience as we continue making important improvements to your neighborhood's water system.

    Existing water meter pit and tree root system intertwine. The finished product of paving and striping work on Morning Drive.
    Rock being removed during excavation.

    Breaking up rock using an air hammer on the excavator.

  • Construction Update: July 6-17

    Share Construction Update: July 6-17 on Facebook Share Construction Update: July 6-17 on X (formerly Twitter) Share Construction Update: July 6-17 on Linkedin Email Construction Update: July 6-17 link

    Hello Loveland!

    Here’s the latest update on construction from July 6 to July 17, along with a look at what’s coming next.

    Construction Progress

    Phase 1 [Complete]: Morning Drive south of 22nd Street

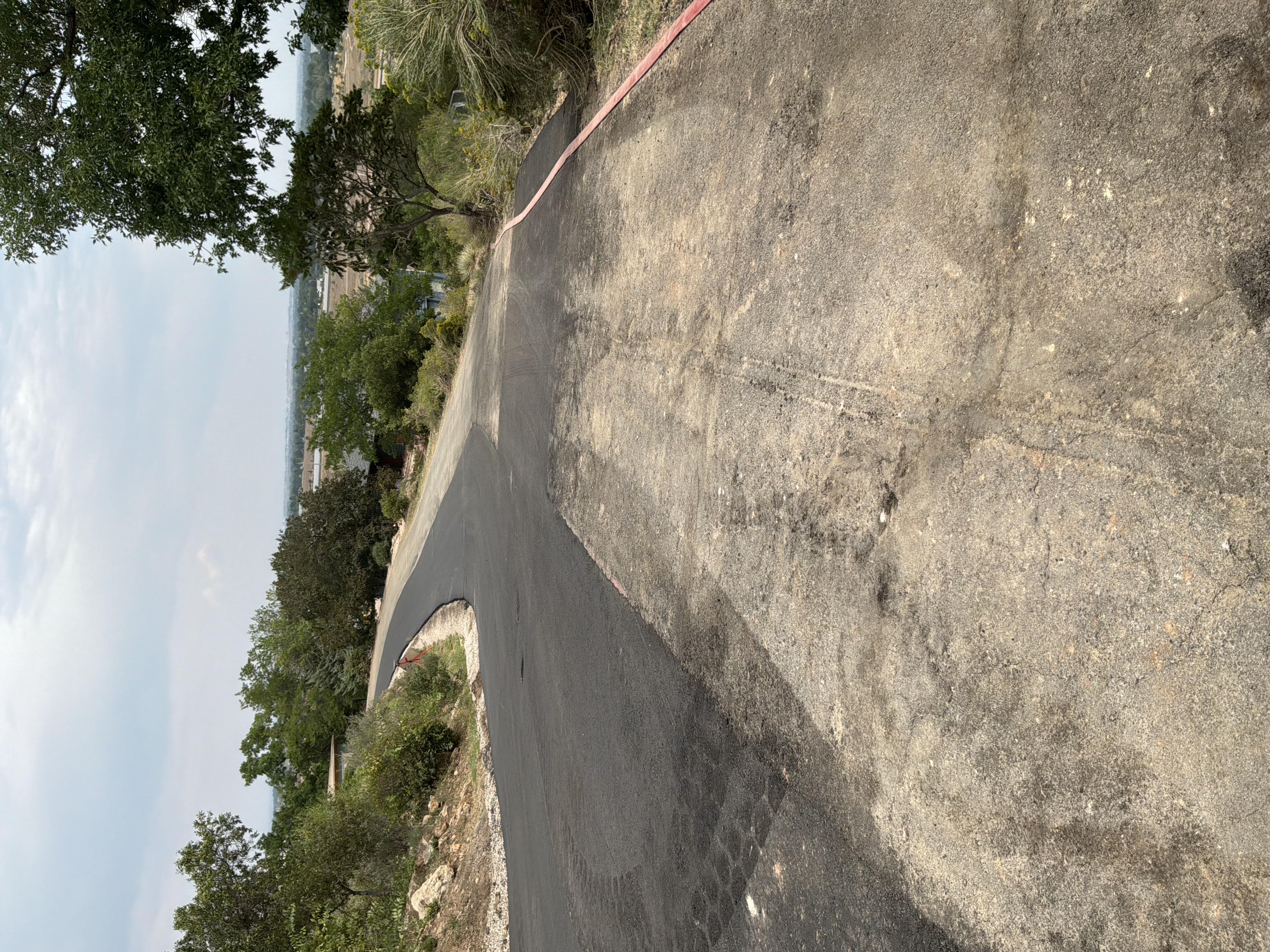

    • Final paving was completed July 17.

    Phase 2 [Complete]: Morning Drive north of 22nd Street

    • Meter pit upgrades are complete.
    • Installation, disinfection and testing of the new 8-inch PVC waterline from W. 22nd Street to the end of the road is finished. Residents are now being served by the new PVC water main instead of temporary water.
    • Final paving was completed July 17.

    Phase 3: Juniper Lane

    • Homes along Juniper Lane are now on temporary water. The temporary service will continue from July 14 to approximately July 31.
    • Crews have begun installing new 8-inch PVC waterline on Juniper Lane, starting at the intersection with Morning Drive.

    Upcoming Work

    Phase 3: Juniper Lane

    • Waterline installation will continue west on Juniper Lane toward Skyrock Road.
    • Meter pits and service lines will be replaced as needed as work progresses.

    Phase 4: Skyrock Road and Ponderosa Drive

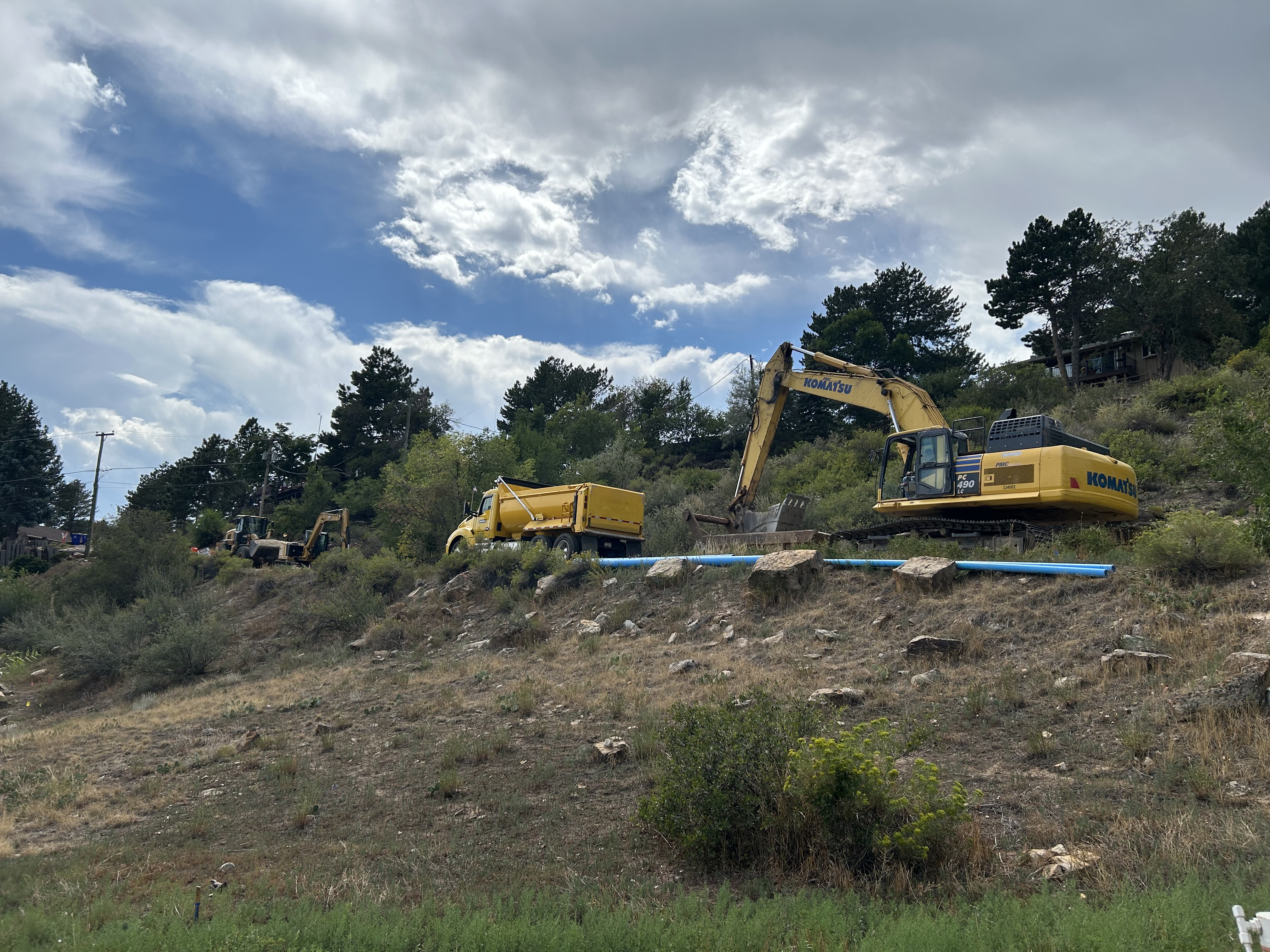

    • Milling on Skyrock Road and Ponderosa Drive will occur in the coming weeks to prepare for waterline construction in August.
    • Build out of temporary water service is expected to being at the end of July or early August.

    Traffic Control

    • Juniper Lane and a portion of Skyrock will be closed to through traffic while construction continues on Juniper Lane.

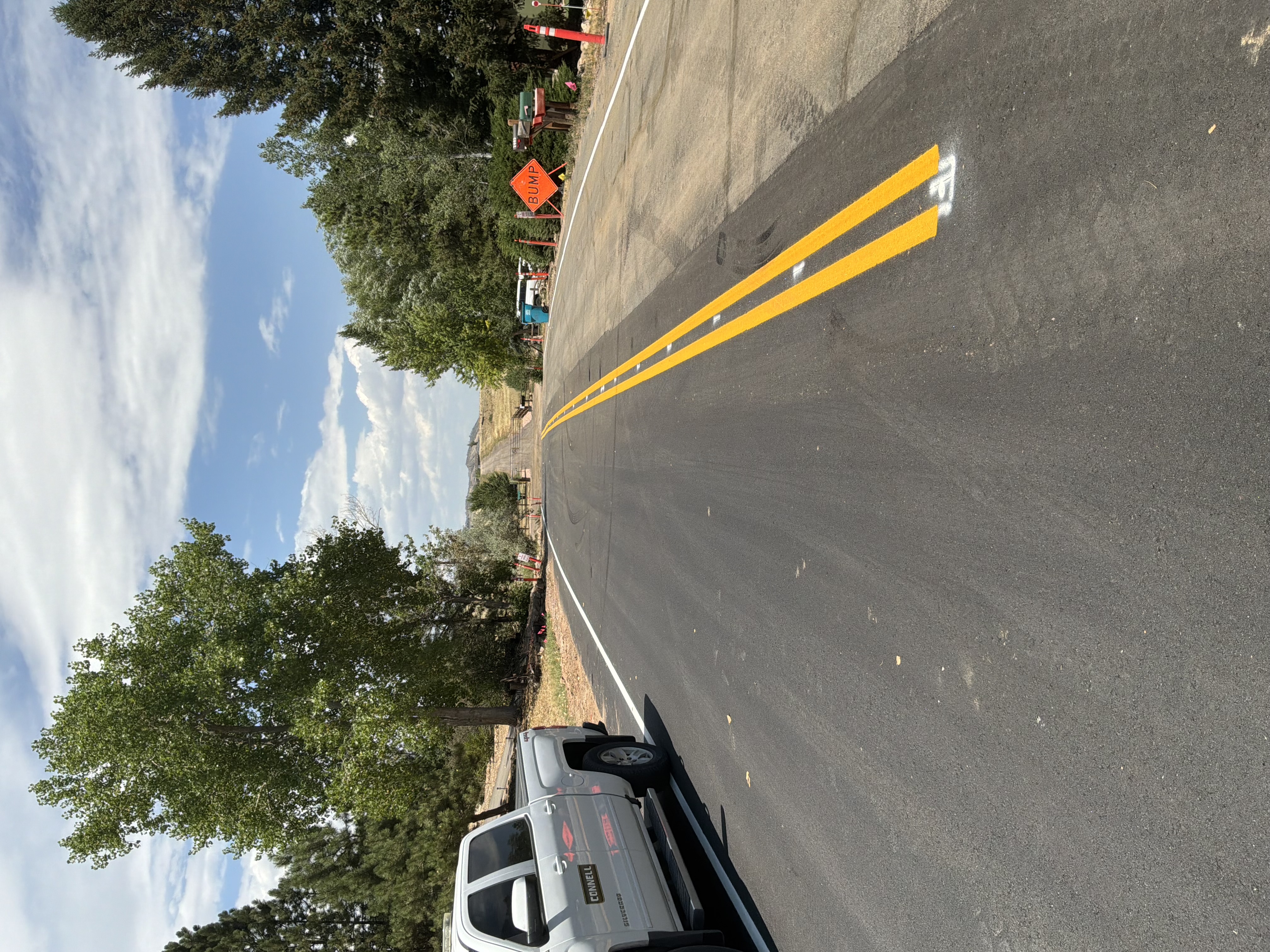

    • Morning Drive is being striped today and is expected to fully reopen Tuesday, July 21.
    • Landscaping restoration on Morning Drive will continue and may result in intermittent activity.
    • Due to the narrow width of Juniper Lane, bypassing construction equipment will be difficult. Residents will need to access their homes from the east or west depending on construction progress.
    • Xcel will replace power poles in the area throughout July, which may cause additional delays or brief obstructions.
    • Additional information about traffic routes and what to expect as crews transition to Phase 4 will be shared via email before traffic control changes occur.

    Thank you for your patience as we continue making important improvements to your neighborhood’s water system

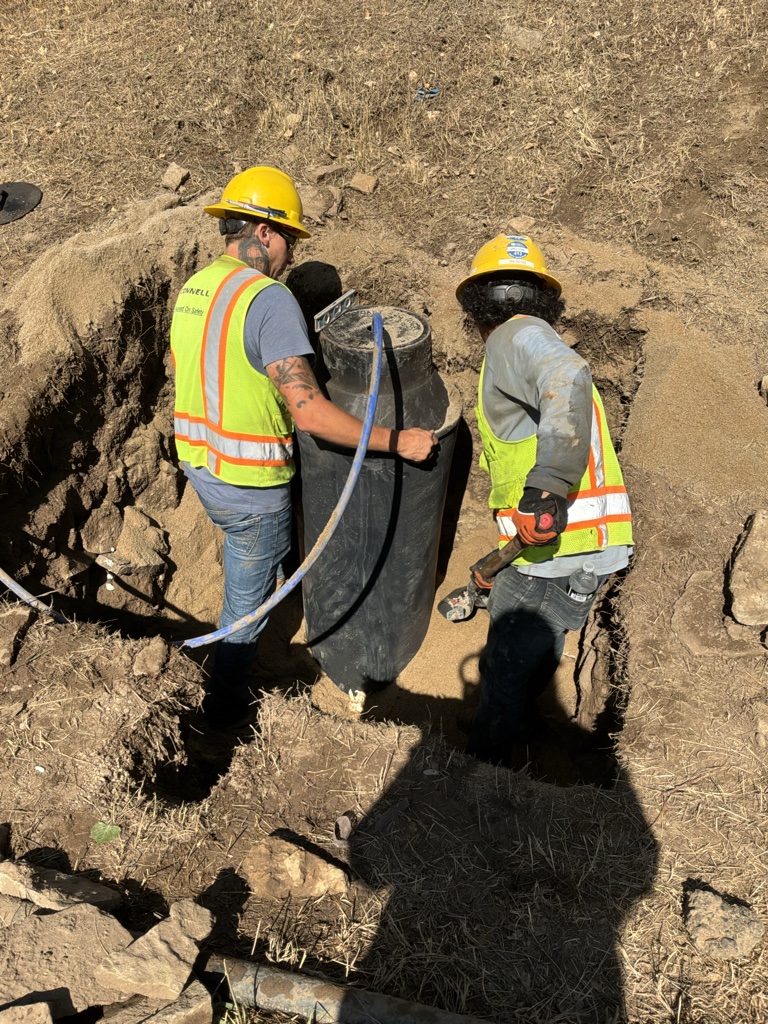

    Crews installing a new meter pit.

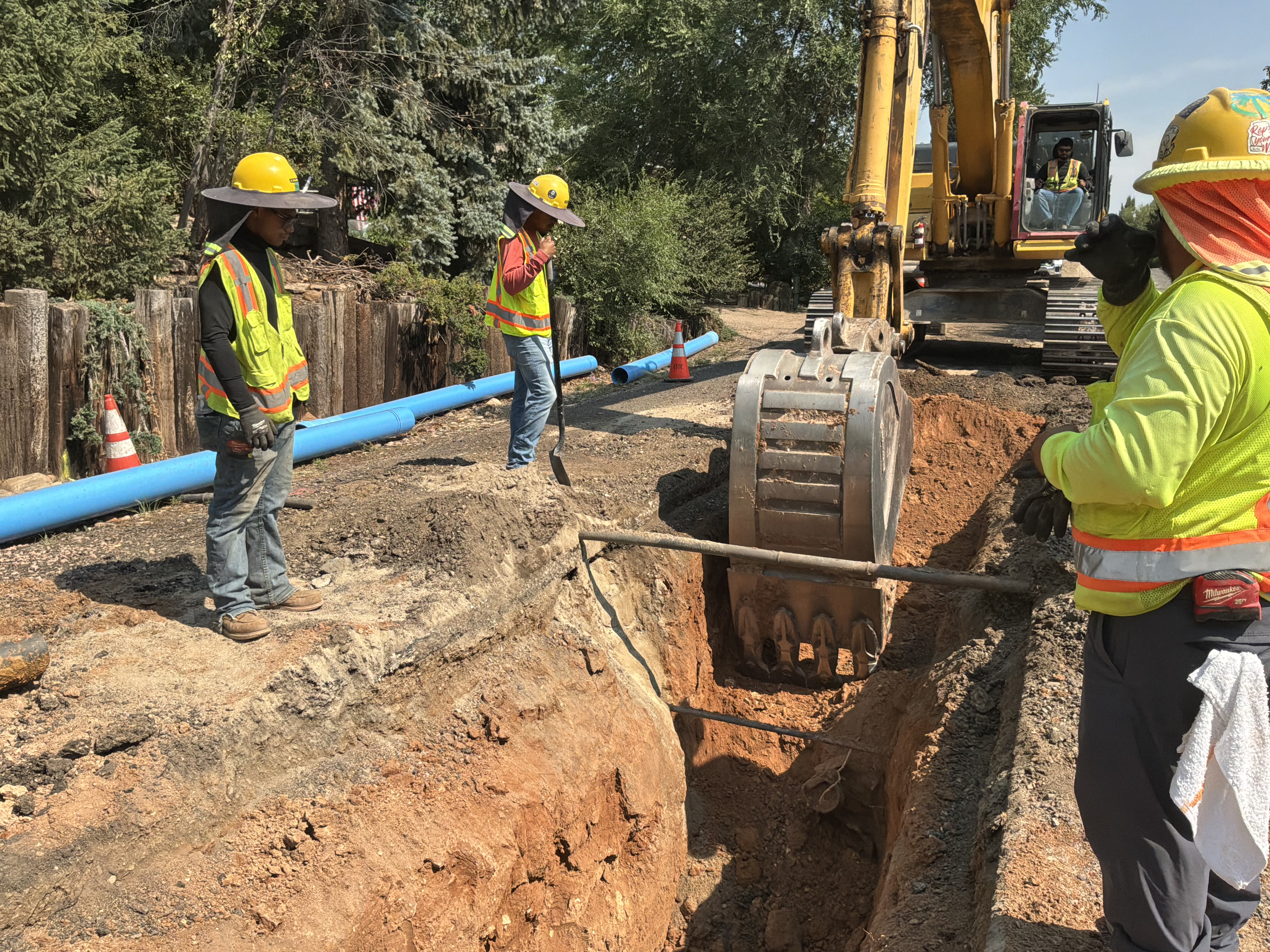

    Crews excavate around crossing utilities.

    Hello Loveland!

    Here’s the latest update on construction from July 6 to July 17, along with a look at what’s coming next.

    Construction Progress

    Phase 1 [Complete]: Morning Drive south of 22nd Street

    • Final paving was completed July 17.

    Phase 2 [Complete]: Morning Drive north of 22nd Street

    • Meter pit upgrades are complete.
    • Installation, disinfection and testing of the new 8-inch PVC waterline from W. 22nd Street to the end of the road is finished. Residents are now being served by the new PVC water main instead of temporary water.
    • Final paving was completed July 17.

    Phase 3: Juniper Lane

    • Homes along Juniper Lane are now on temporary water. The temporary service will continue from July 14 to approximately July 31.
    • Crews have begun installing new 8-inch PVC waterline on Juniper Lane, starting at the intersection with Morning Drive.

    Upcoming Work

    Phase 3: Juniper Lane

    • Waterline installation will continue west on Juniper Lane toward Skyrock Road.
    • Meter pits and service lines will be replaced as needed as work progresses.

    Phase 4: Skyrock Road and Ponderosa Drive

    • Milling on Skyrock Road and Ponderosa Drive will occur in the coming weeks to prepare for waterline construction in August.
    • Build out of temporary water service is expected to being at the end of July or early August.

    Traffic Control

    • Juniper Lane and a portion of Skyrock will be closed to through traffic while construction continues on Juniper Lane.
    • Morning Drive is being striped today and is expected to fully reopen Tuesday, July 21.
    • Landscaping restoration on Morning Drive will continue and may result in intermittent activity.
    • Due to the narrow width of Juniper Lane, bypassing construction equipment will be difficult. Residents will need to access their homes from the east or west depending on construction progress.
    • Xcel will replace power poles in the area throughout July, which may cause additional delays or brief obstructions.
    • Additional information about traffic routes and what to expect as crews transition to Phase 4 will be shared via email before traffic control changes occur.

    Thank you for your patience as we continue making important improvements to your neighborhood’s water system

    Crews installing a new meter pit.

    Crews excavate around crossing utilities.

  • Construction Update: June 22 to July 3

    Share Construction Update: June 22 to July 3 on Facebook Share Construction Update: June 22 to July 3 on X (formerly Twitter) Share Construction Update: June 22 to July 3 on Linkedin Email Construction Update: June 22 to July 3 link

    Hello Loveland!

    Here’s the latest update on construction from June 22 to July 3, along with a look at what’s coming up next.

    Construction Progress

    Phase 1:

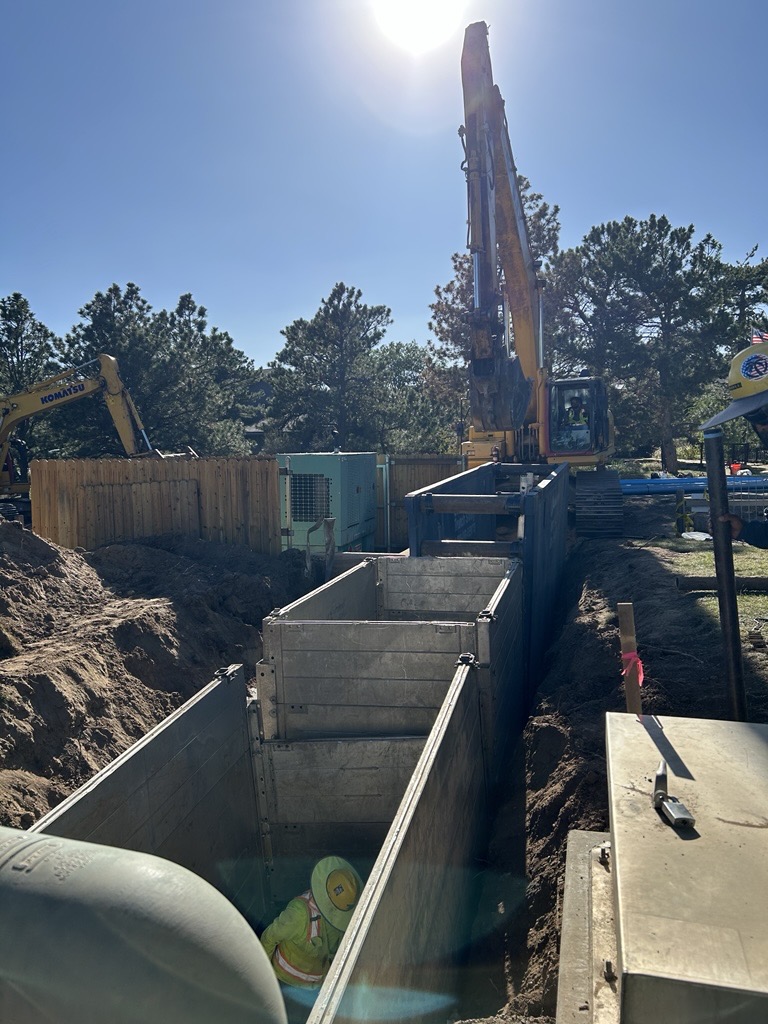

    • Waterline replacement from the Pump Station on Morning Drive to W. 22nd Street is now complete and in service. Residents in this section have received upgraded meter pits and are now being served from the new PVC water main instead of temporary water.
    • Initial paving on Morning Drive from Skyrock to W. 22nd Street took place Monday, June 29. Final paving is expected in the coming weeks.

    Phase 2:

    • Homes in Phase 2, Morning Drive north of W. 22nd Street to the end of the road, are now on temporary water. The temporary system will serve these homes from June 30 to about July 24.
    • Crews have begun installing new 8‑inch PVC waterline north of W. 22nd Street. New meter pits and service lines have also been installed where needed as the new line goes in.

    Phase 3:

    • The north side of Juniper Lane was milled to prepare for waterline installation planned for late July and August.

    Upcoming Work

    • Crews will continue installing new waterline to the north on Morning Drive from 22nd Street to the end of the road. Meter pits will be replaced as needed and project staff will reach out to discuss any necessary replacements and coordination with homeowners.
    • Final paving of all of Morning Drive is expected mid-July or just after.
    • Temporary water service for Phase 3, along Juniper Lane, will be built out, tested and disinfected. Once that is complete, residents will be moved onto the temporary water service as crews being waterline replacement in this area later in July.

    Traffic Control

    • Traffic control remains largely the same as construction continues north along Morning Drive.
    • Morning Drive will stay closed to through traffic while open excavations are present. Homeowners will continue to have access but may need to use the Skyrock Road to Juniper Lane detour to avoid active construction.
    • Xcel will begin replacement of electric poles in the area in July, which may lead to additional delays or brief obstructions.
    • Additional information about traffic routes and what to expect after the paving of Morning Drive and the transition of waterline replacement along Juniper Lane will be sent out next week.

    Thank you for your patience as we make these important improvements to your neighborhood’s water system.

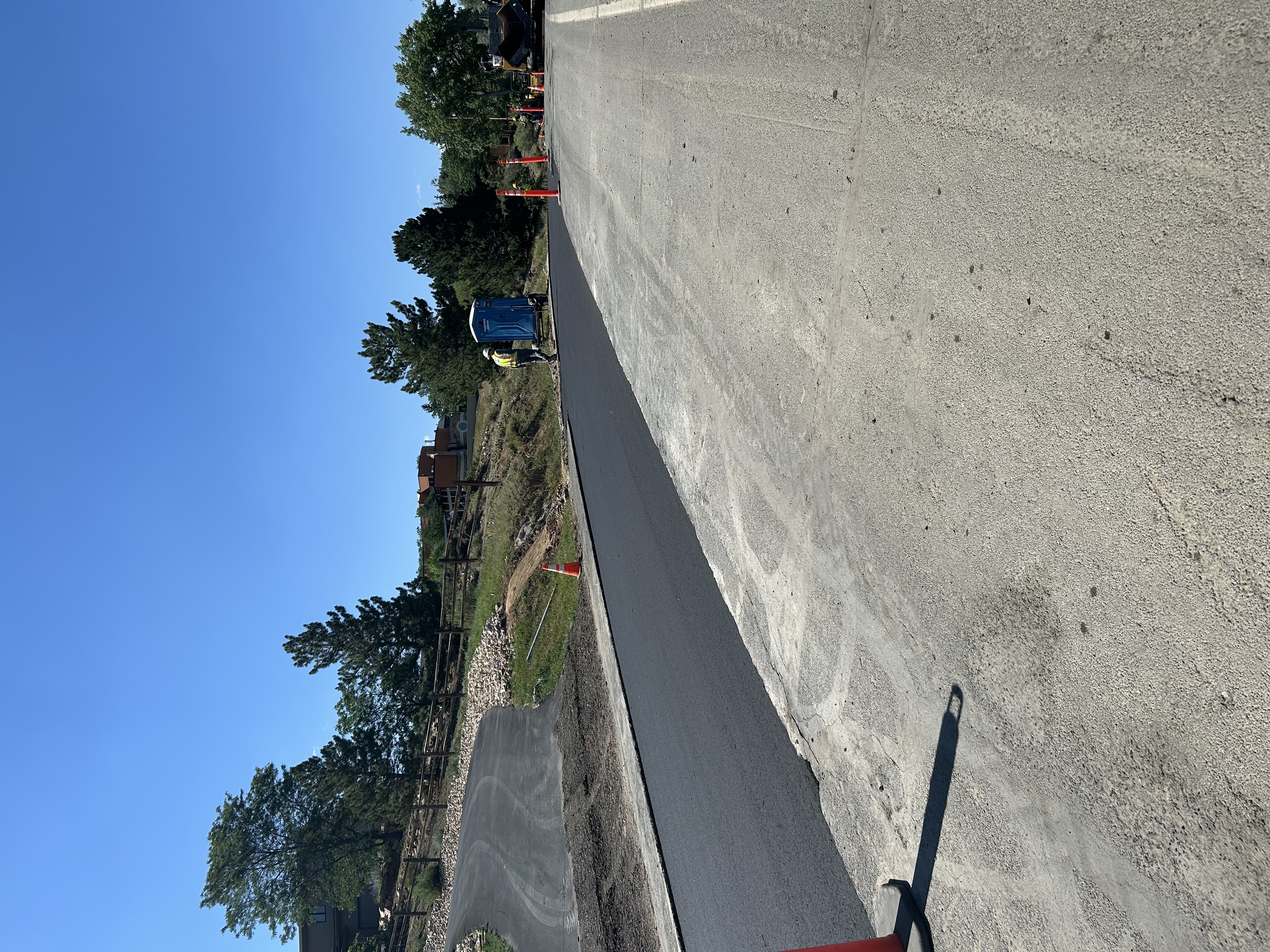

    A "bottom mat" of paving is installed on Morning Drive.

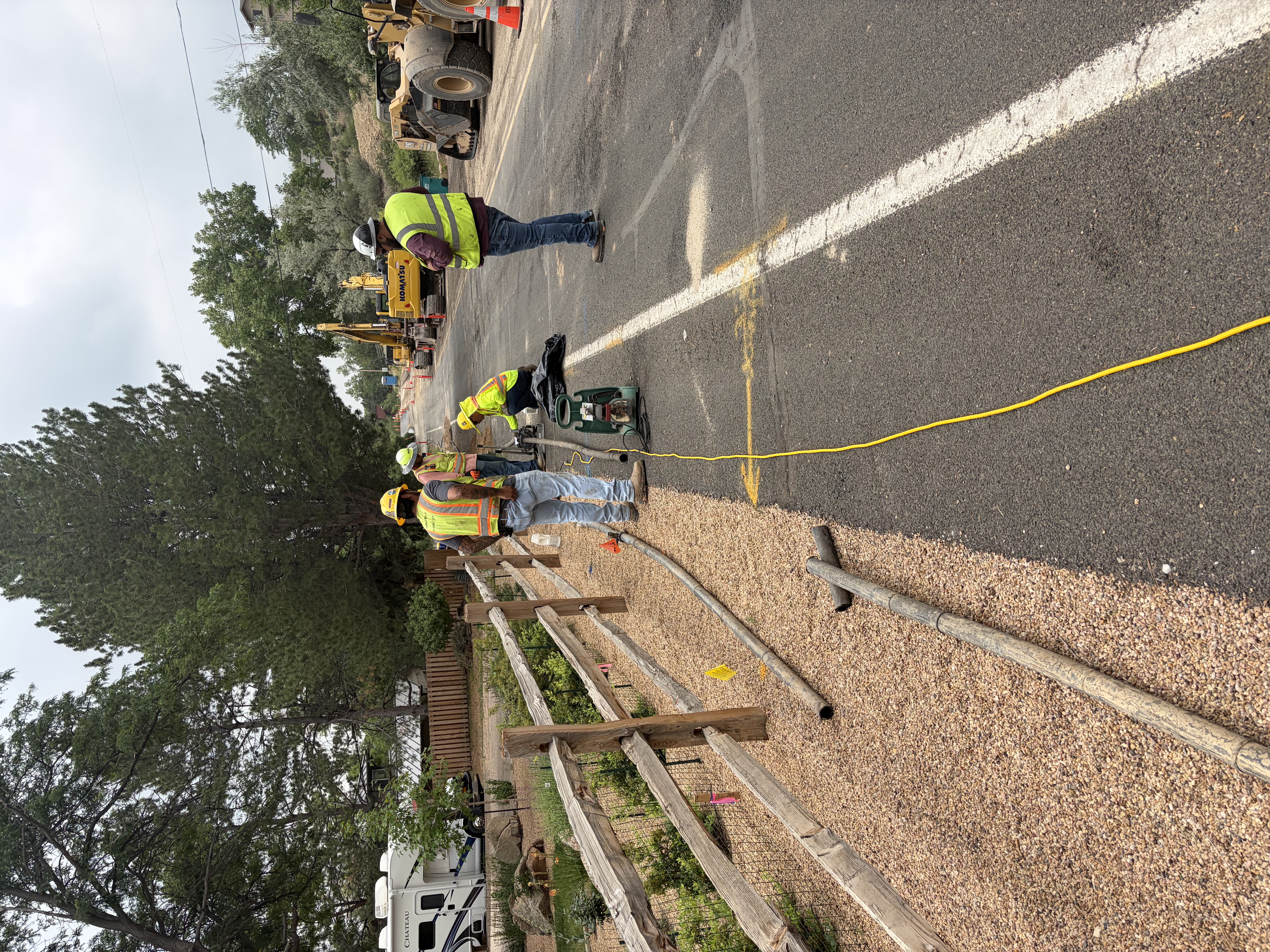

    Crews build a temporary water system in Phase 2 (Morning Drive north of 22nd Street).

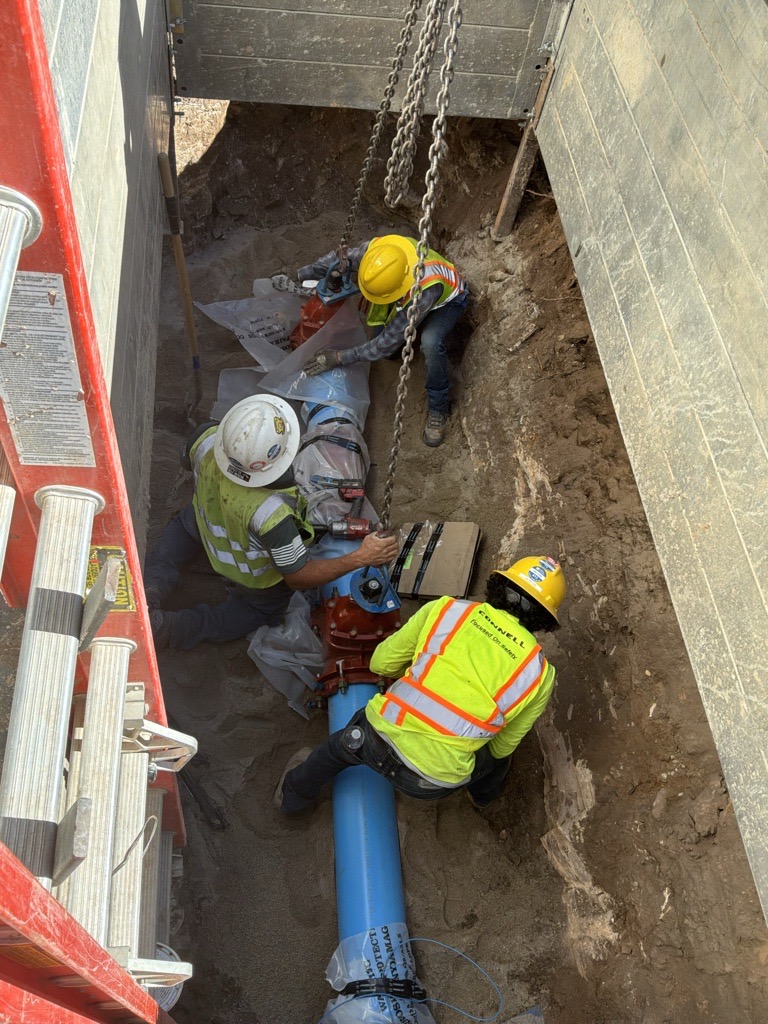

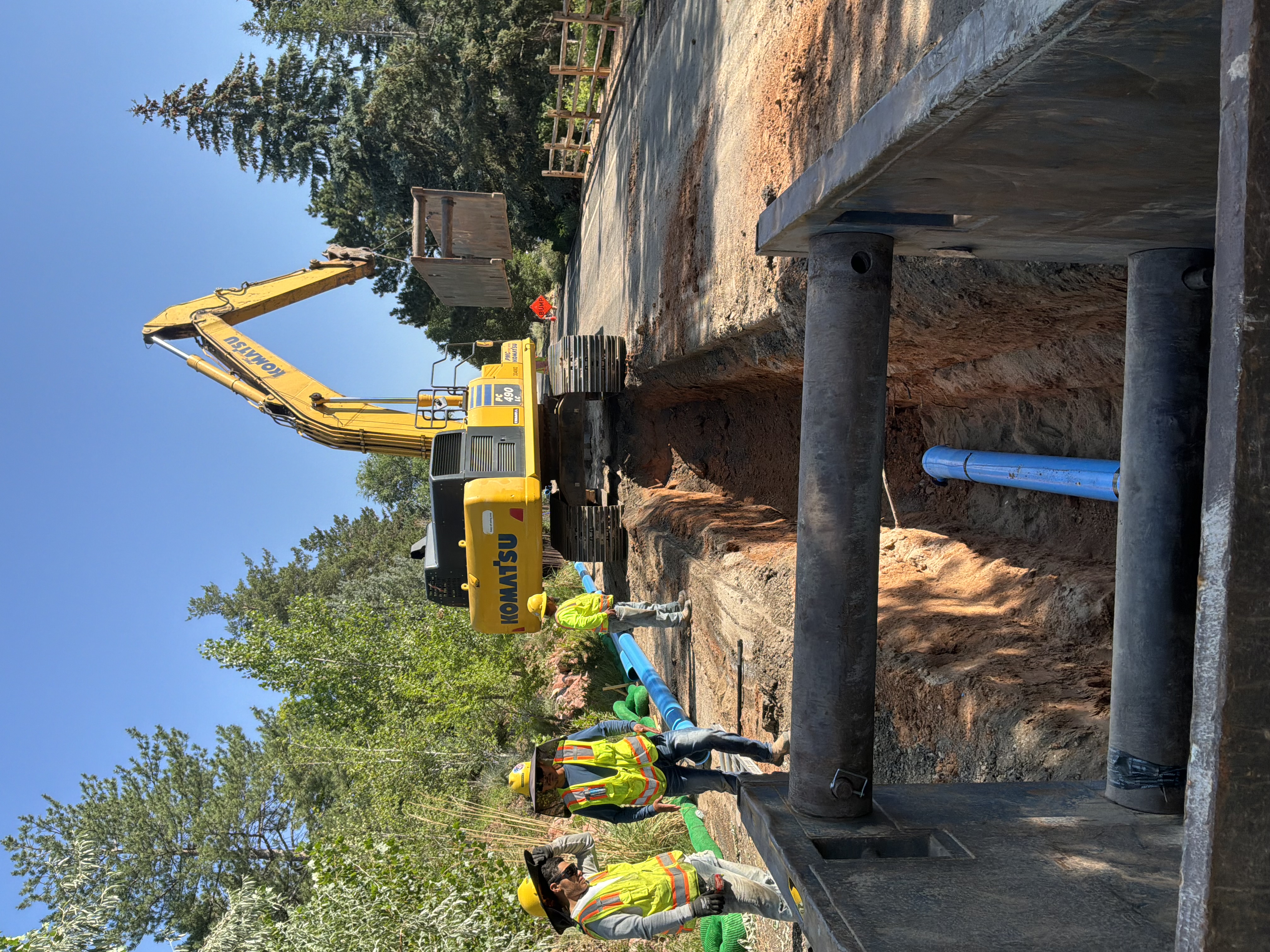

    Crews install waterline north of 22nd Street.

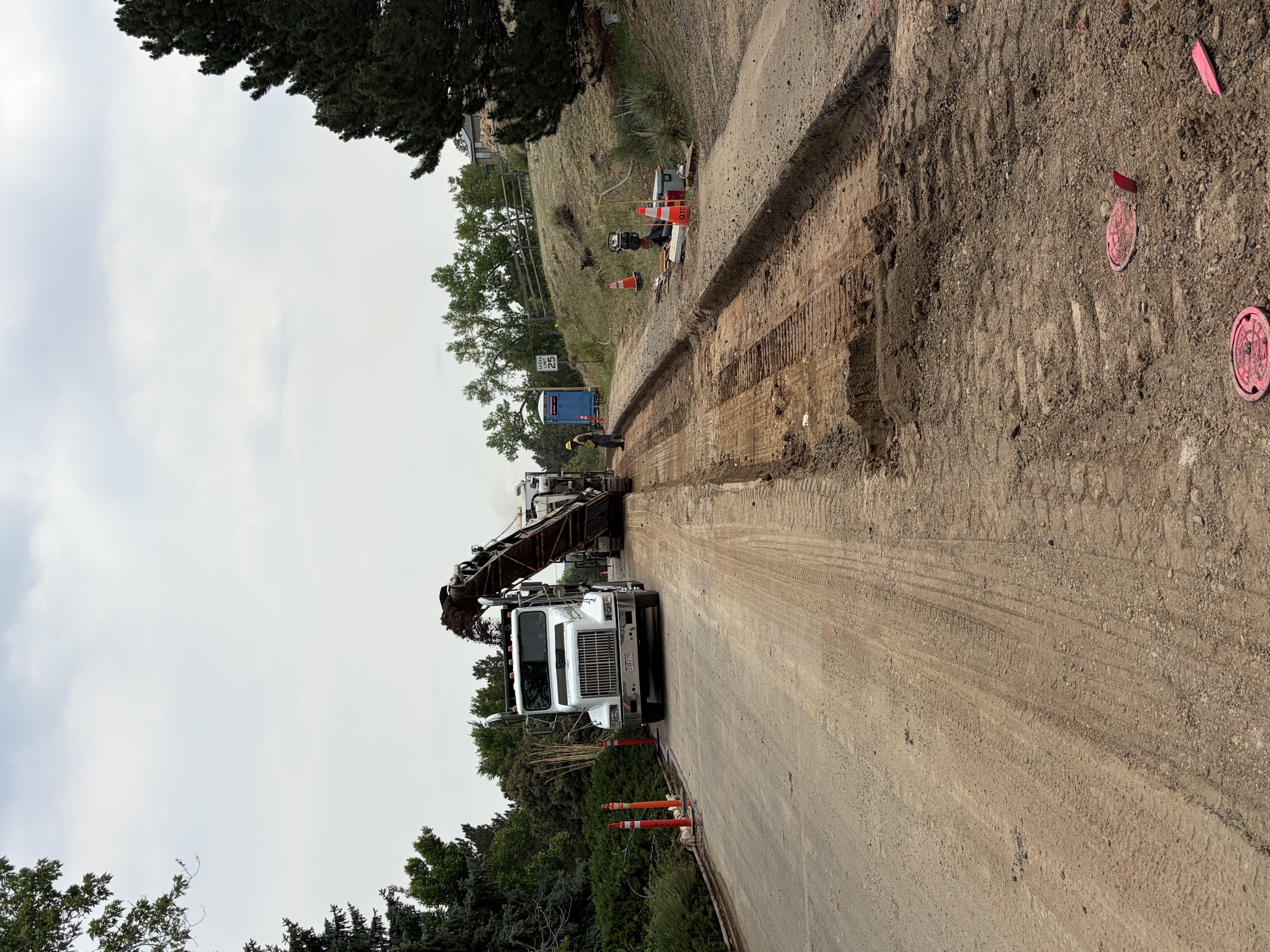

    Milling operations in progress.

    Hello Loveland!

    Here’s the latest update on construction from June 22 to July 3, along with a look at what’s coming up next.

    Construction Progress

    Phase 1:

    • Waterline replacement from the Pump Station on Morning Drive to W. 22nd Street is now complete and in service. Residents in this section have received upgraded meter pits and are now being served from the new PVC water main instead of temporary water.
    • Initial paving on Morning Drive from Skyrock to W. 22nd Street took place Monday, June 29. Final paving is expected in the coming weeks.

    Phase 2:

    • Homes in Phase 2, Morning Drive north of W. 22nd Street to the end of the road, are now on temporary water. The temporary system will serve these homes from June 30 to about July 24.
    • Crews have begun installing new 8‑inch PVC waterline north of W. 22nd Street. New meter pits and service lines have also been installed where needed as the new line goes in.

    Phase 3:

    • The north side of Juniper Lane was milled to prepare for waterline installation planned for late July and August.

    Upcoming Work

    • Crews will continue installing new waterline to the north on Morning Drive from 22nd Street to the end of the road. Meter pits will be replaced as needed and project staff will reach out to discuss any necessary replacements and coordination with homeowners.
    • Final paving of all of Morning Drive is expected mid-July or just after.
    • Temporary water service for Phase 3, along Juniper Lane, will be built out, tested and disinfected. Once that is complete, residents will be moved onto the temporary water service as crews being waterline replacement in this area later in July.

    Traffic Control

    • Traffic control remains largely the same as construction continues north along Morning Drive.
    • Morning Drive will stay closed to through traffic while open excavations are present. Homeowners will continue to have access but may need to use the Skyrock Road to Juniper Lane detour to avoid active construction.
    • Xcel will begin replacement of electric poles in the area in July, which may lead to additional delays or brief obstructions.
    • Additional information about traffic routes and what to expect after the paving of Morning Drive and the transition of waterline replacement along Juniper Lane will be sent out next week.

    Thank you for your patience as we make these important improvements to your neighborhood’s water system.

    A "bottom mat" of paving is installed on Morning Drive.

    Crews build a temporary water system in Phase 2 (Morning Drive north of 22nd Street).

    Crews install waterline north of 22nd Street.

    Milling operations in progress.

  • Construction Update: June 8-19

    Share Construction Update: June 8-19 on Facebook Share Construction Update: June 8-19 on X (formerly Twitter) Share Construction Update: June 8-19 on Linkedin Email Construction Update: June 8-19 link

    Hello Loveland!

    Here’s the latest update on construction from June 8 to June 19, along with a look at what’s coming up next.

    Construction Progress

    • Crews have completed the first phase of waterline replacement on Morning Drive from Skyrock Road to W. 22nd Street. The existing 6‑inch cast iron line was upgraded to 8‑inch PVC line.
    • Meter pits for homes on Morning Drive south of W. 22nd St. continue to be replaced as needed. Many pits are aging and in bad shape. Crews even uncovered one with a wood barrel.
    • The temporary water system for Phase 2 is being laid out in front of homes on Morning Drive north of W. 22nd St.

    Upcoming Work

    • The new waterline on Morning Drive from Skyrock Road to W. 22nd Street will be tested and disinfected. Once the line is cleared for resuming water service, residents currently on temporary water will be reconnected to regular service and tied into the new main line. Temporary water service equipment will then be removed.
    • Paving on Morning Drive south of 22nd is scheduled in the coming weeks.
    • Temporary water service for Phase 2, Morning Drive north of 22nd Street, will continue to be built out, tested and disinfected. Once that is complete, residents will be moved onto the temporary water service as crews being waterline replacement in this area to the end of the road.

    Traffic Control

    • Traffic control remains largely the same as construction continues north along Morning Drive.
    • Morning Drive will stay closed to through traffic while open excavations are present. Homeowners will continue to have access but may need to use the Skyrock Road to Juniper Lane detour to avoid active construction.
    • Juniper Lane is being milled on Monday, June 22 to prepare for upcoming construction. Crews on site are directing traffic as needed to keep the detour open and maintain local access.

    Thank you for your patience as we make these important improvements to your neighborhood’s water system.

    Crews working to install new waterline on Morning Drive.

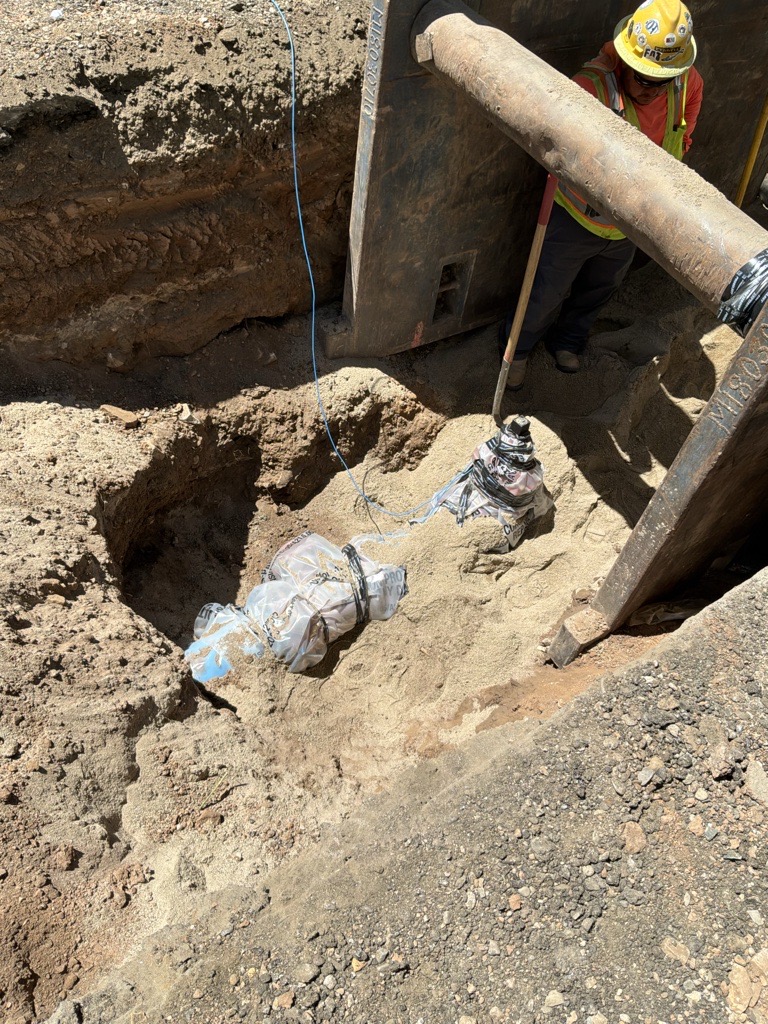

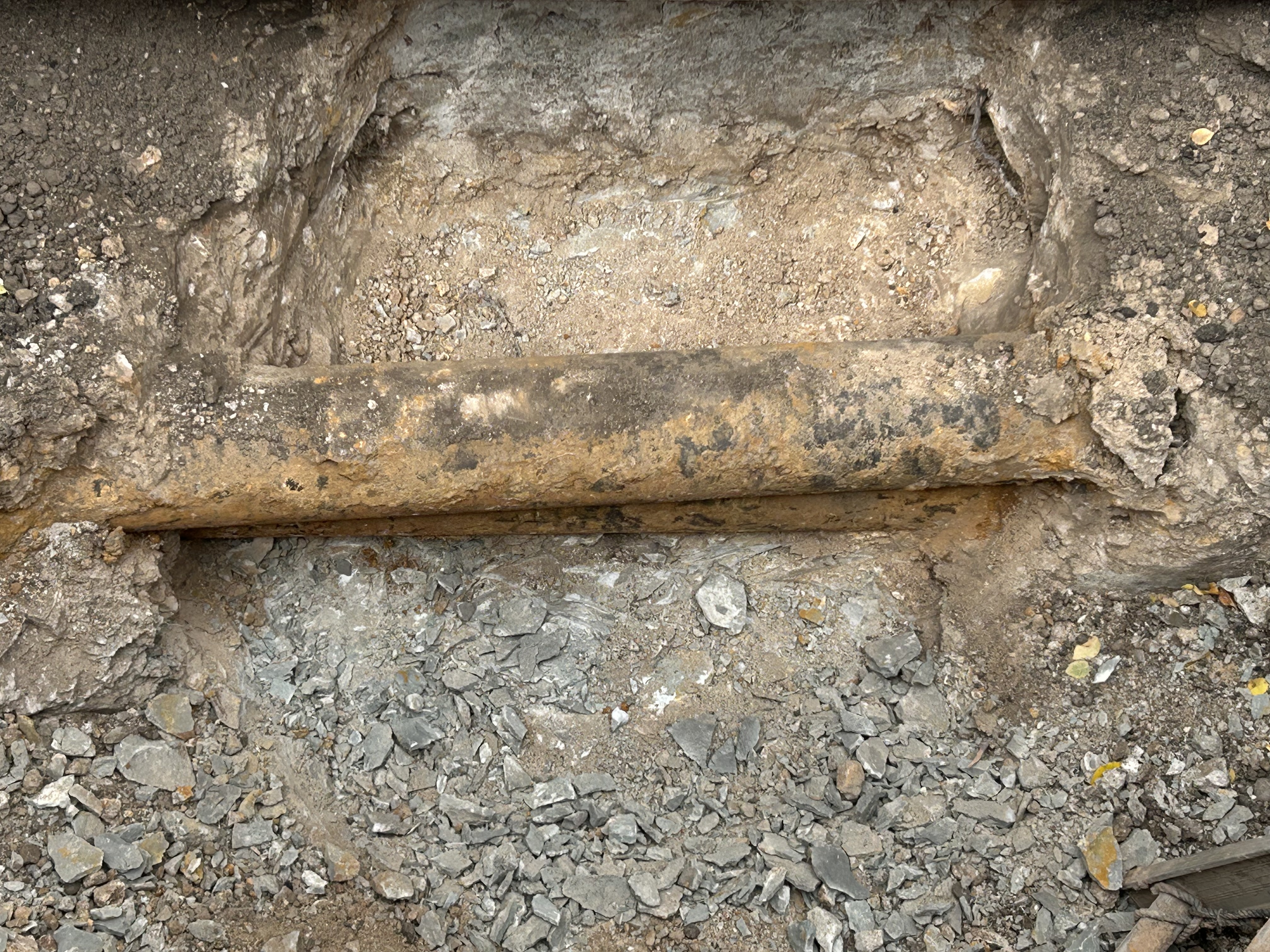

    It may look like any other pipe, but this photo captures a major project milestone: the end of Phase 1 waterline replacement.

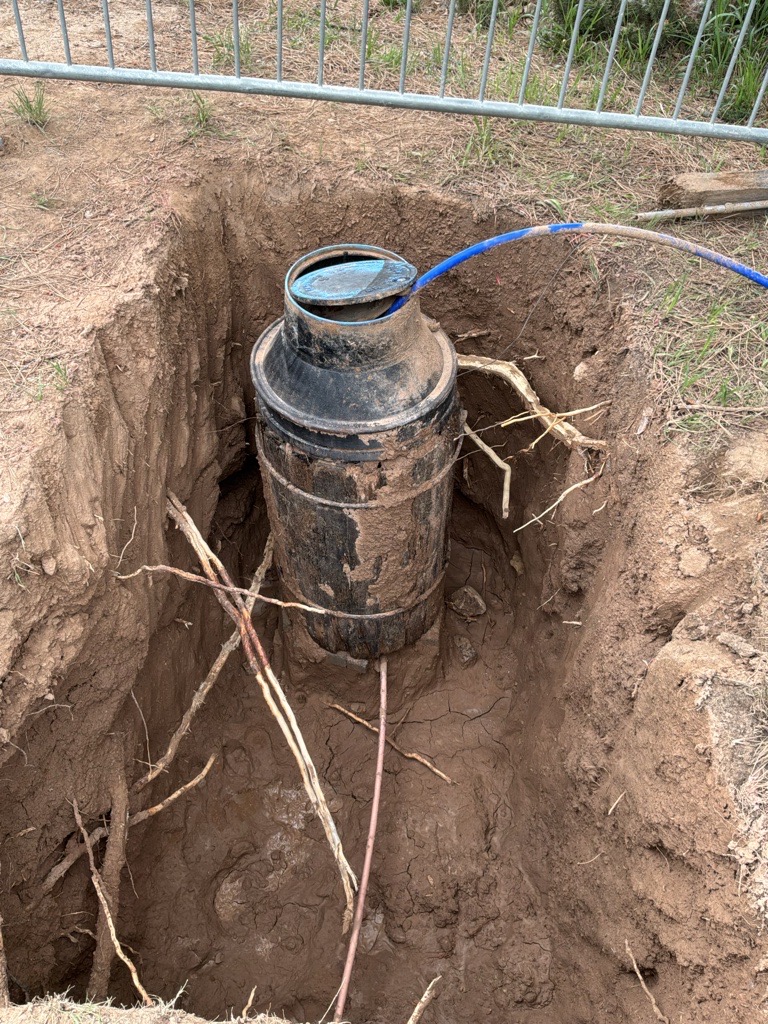

    Crews were amused to find this meter pit featured an old wood barrel.

    Hello Loveland!

    Here’s the latest update on construction from June 8 to June 19, along with a look at what’s coming up next.

    Construction Progress

    • Crews have completed the first phase of waterline replacement on Morning Drive from Skyrock Road to W. 22nd Street. The existing 6‑inch cast iron line was upgraded to 8‑inch PVC line.
    • Meter pits for homes on Morning Drive south of W. 22nd St. continue to be replaced as needed. Many pits are aging and in bad shape. Crews even uncovered one with a wood barrel.
    • The temporary water system for Phase 2 is being laid out in front of homes on Morning Drive north of W. 22nd St.

    Upcoming Work

    • The new waterline on Morning Drive from Skyrock Road to W. 22nd Street will be tested and disinfected. Once the line is cleared for resuming water service, residents currently on temporary water will be reconnected to regular service and tied into the new main line. Temporary water service equipment will then be removed.
    • Paving on Morning Drive south of 22nd is scheduled in the coming weeks.
    • Temporary water service for Phase 2, Morning Drive north of 22nd Street, will continue to be built out, tested and disinfected. Once that is complete, residents will be moved onto the temporary water service as crews being waterline replacement in this area to the end of the road.

    Traffic Control

    • Traffic control remains largely the same as construction continues north along Morning Drive.
    • Morning Drive will stay closed to through traffic while open excavations are present. Homeowners will continue to have access but may need to use the Skyrock Road to Juniper Lane detour to avoid active construction.
    • Juniper Lane is being milled on Monday, June 22 to prepare for upcoming construction. Crews on site are directing traffic as needed to keep the detour open and maintain local access.

    Thank you for your patience as we make these important improvements to your neighborhood’s water system.

    Crews working to install new waterline on Morning Drive.

    It may look like any other pipe, but this photo captures a major project milestone: the end of Phase 1 waterline replacement.

    Crews were amused to find this meter pit featured an old wood barrel.

  • Construction Update May 25 to June 5

    Share Construction Update May 25 to June 5 on Facebook Share Construction Update May 25 to June 5 on X (formerly Twitter) Share Construction Update May 25 to June 5 on Linkedin Email Construction Update May 25 to June 5 link

    Hello Loveland!

    Here's the latest update on construction from May 11 to May 22 with a look at upcoming weeks as well.

    Construction Progress:

    • Crews removed the existing 6‑inch cast iron pump station waterline connection and installed a new 8‑inch PVC line which was disinfected, passed inspection and brought online June 2.
    • The temporary water system built along the shoulders of Morning Drive was been disinfected, passed inspection and connected to homes south of W. 22nd St. Homes in this area can expect to be on the temporary water system until July.
    • Crews have been busy excavating bedrock and have begun replacing the main waterline on Morning Drive south of 22nd Street with new 8‑inch PVC pipe.

    Upcoming Work

    • Construction will continue north along Morning Drive, excavating bedrock and replacing the main waterline.
    • Meter pits for homes south of W. 22nd St. will be replaced as needed. The City or contractor will coordinate individually with affected homeowners.
    • Crews will prep for temporary water connections to homes on Morning Drive north of 22nd Street.
    • Milling plans are being developed for Juniper Lane in anticipation of construction beginning in the next few weeks.

    Traffic Control

    Traffic control will largely remain the same as construction continues north along Morning Drive.

    • Morning Drive will remain closed to through traffic while open excavations are present.
    • Homeowners on Morning Drive may need to use the detour to avoid construction areas, but access to homes will be maintained.
    • Skyrock Road to Juniper Lane will remain the designated detour.

    Thank you for your patience as we make these improvements.

    Construction trench with temporary orange fencing around it.Work on the new pump station connection.

    Heavy equipment shown digging along roadway.Work backfilling the new pump station connection.

    Construction trench with heavy digging equipment shown behind.Work replacing the waterline in Morning Drive.

    Hello Loveland!

    Here's the latest update on construction from May 11 to May 22 with a look at upcoming weeks as well.

    Construction Progress:

    • Crews removed the existing 6‑inch cast iron pump station waterline connection and installed a new 8‑inch PVC line which was disinfected, passed inspection and brought online June 2.
    • The temporary water system built along the shoulders of Morning Drive was been disinfected, passed inspection and connected to homes south of W. 22nd St. Homes in this area can expect to be on the temporary water system until July.
    • Crews have been busy excavating bedrock and have begun replacing the main waterline on Morning Drive south of 22nd Street with new 8‑inch PVC pipe.

    Upcoming Work

    • Construction will continue north along Morning Drive, excavating bedrock and replacing the main waterline.
    • Meter pits for homes south of W. 22nd St. will be replaced as needed. The City or contractor will coordinate individually with affected homeowners.
    • Crews will prep for temporary water connections to homes on Morning Drive north of 22nd Street.
    • Milling plans are being developed for Juniper Lane in anticipation of construction beginning in the next few weeks.

    Traffic Control

    Traffic control will largely remain the same as construction continues north along Morning Drive.

    • Morning Drive will remain closed to through traffic while open excavations are present.
    • Homeowners on Morning Drive may need to use the detour to avoid construction areas, but access to homes will be maintained.
    • Skyrock Road to Juniper Lane will remain the designated detour.

    Thank you for your patience as we make these improvements.

    Construction trench with temporary orange fencing around it.Work on the new pump station connection.

    Heavy equipment shown digging along roadway.Work backfilling the new pump station connection.

    Construction trench with heavy digging equipment shown behind.Work replacing the waterline in Morning Drive.

  • Construction Update: May 11-22

    Share Construction Update: May 11-22 on Facebook Share Construction Update: May 11-22 on X (formerly Twitter) Share Construction Update: May 11-22 on Linkedin Email Construction Update: May 11-22 link

    Hello Loveland!

    Here's the latest update on construction from May 11 to May 22 with a look at upcoming weeks as well.

    Construction Progress

    • The pump station shutdown on Morning Drive occurred May 12.
      • Resident participation in reducing water use helped make the shutdown successful.
      • During the shutdown, crews installed a new hydrant and valves to support the temporary pump station connection.
    • Crews, built, tested and installed a temporary connection to the pump station. This line, which came online May 21, will remain in service for about two weeks.
    • Excavation and removal of the existing 6-inch cast iron waterline to the pump station is underway, followed by installation of an 8-inch PVC replacement.

    Upcoming Work

    • Replacement of the existing 6-inch cast iron line with 8-inch PVC at the pump station will be completed along with disinfection, testing and final connections.
    • The temporary water system built along the shoulders of Morning Drive will be disinfected, tested and connected to homes south of W. 22nd Street.
    • Waterline replacement on Morning Drive is expected to begin in about two weeks.

    Traffic Control

    • Morning Drive will remain closed to through traffic while open excavations are present.
    • Homeowners on Morning Drive may need to use the detour to avoid construction areas, but access to homes will be maintained.
    • Skyrock Road to Juniper Lane will remain the designated detour.

    Thank you for your patience as we make these improvements.

    Crews work to install the new permanent pump station connection.

    A view of newly installed valves and "tee" for a fire hydrant connection.

    Hello Loveland!

    Here's the latest update on construction from May 11 to May 22 with a look at upcoming weeks as well.

    Construction Progress

    • The pump station shutdown on Morning Drive occurred May 12.
      • Resident participation in reducing water use helped make the shutdown successful.
      • During the shutdown, crews installed a new hydrant and valves to support the temporary pump station connection.
    • Crews, built, tested and installed a temporary connection to the pump station. This line, which came online May 21, will remain in service for about two weeks.
    • Excavation and removal of the existing 6-inch cast iron waterline to the pump station is underway, followed by installation of an 8-inch PVC replacement.

    Upcoming Work

    • Replacement of the existing 6-inch cast iron line with 8-inch PVC at the pump station will be completed along with disinfection, testing and final connections.
    • The temporary water system built along the shoulders of Morning Drive will be disinfected, tested and connected to homes south of W. 22nd Street.
    • Waterline replacement on Morning Drive is expected to begin in about two weeks.

    Traffic Control

    • Morning Drive will remain closed to through traffic while open excavations are present.
    • Homeowners on Morning Drive may need to use the detour to avoid construction areas, but access to homes will be maintained.
    • Skyrock Road to Juniper Lane will remain the designated detour.

    Thank you for your patience as we make these improvements.

    Crews work to install the new permanent pump station connection.

    A view of newly installed valves and "tee" for a fire hydrant connection.

  • Construction Update: April 27-May 8

    Share Construction Update: April 27-May 8 on Facebook Share Construction Update: April 27-May 8 on X (formerly Twitter) Share Construction Update: April 27-May 8 on Linkedin Email Construction Update: April 27-May 8 link

    Hello Loveland!

    Construction on the Namaqua Hills Waterline Replacement Project officially began on April 27th. Here's the latest update on construction from April 27th-May 8th with a look at upcoming weeks as well.

    Construction Progress

    • Crews milled the roadway to prepare for the waterline trench.
    • Crews worked on temporary water installation and potholing to identify existing utilities.
      • Temporary above‑ground waterlines were installed for future use and are visible in the roadway shoulders.
      • Ramps made of millings were placed where temporary lines cross driveways or the road to protect the pipe. All ramps are sloped for lower vehicles.
    • A small shutdown occurred April 30 to install two valves, one on Morning Drive and one on Juniper near the intersection with Morning Drive.
      • These valves will allow the contractor to isolate the existing waterline during construction and minimize future outages and impacts to residents.

    Traffic Control

    • Morning Drive will remain closed to through traffic, but homeowners will continue to have access.
    • Skyrock to Juniper will remain the designated detour.

    Upcoming Work

    • A pump station shutdown on Morning Drive is scheduled for May 12.
      • The City asks residents to avoid lawn watering and minimize water use from 10 a.m. to 2 p.m. to help prevent outages during the shutdown.
    • Crews will install a temporary bypass of the pump station to maintain service during work
    • Excavation and removal of the existing 6‑inch cast iron waterline will begin, followed by installation of an 8‑inch PVC line.

    Thank you for your patience as we make these improvements.

    Hello Loveland!

    Construction on the Namaqua Hills Waterline Replacement Project officially began on April 27th. Here's the latest update on construction from April 27th-May 8th with a look at upcoming weeks as well.

    Construction Progress

    • Crews milled the roadway to prepare for the waterline trench.
    • Crews worked on temporary water installation and potholing to identify existing utilities.
      • Temporary above‑ground waterlines were installed for future use and are visible in the roadway shoulders.
      • Ramps made of millings were placed where temporary lines cross driveways or the road to protect the pipe. All ramps are sloped for lower vehicles.
    • A small shutdown occurred April 30 to install two valves, one on Morning Drive and one on Juniper near the intersection with Morning Drive.
      • These valves will allow the contractor to isolate the existing waterline during construction and minimize future outages and impacts to residents.

    Traffic Control

    • Morning Drive will remain closed to through traffic, but homeowners will continue to have access.
    • Skyrock to Juniper will remain the designated detour.

    Upcoming Work

    • A pump station shutdown on Morning Drive is scheduled for May 12.
      • The City asks residents to avoid lawn watering and minimize water use from 10 a.m. to 2 p.m. to help prevent outages during the shutdown.
    • Crews will install a temporary bypass of the pump station to maintain service during work
    • Excavation and removal of the existing 6‑inch cast iron waterline will begin, followed by installation of an 8‑inch PVC line.

    Thank you for your patience as we make these improvements.
